The City is improving Leaside Memorial Gardens Arena as part of a state-of-good-repair project that will replace the existing ice rink pad (rink B), refrigeration system, roof, and upgrade the mechanical and electrical system within the old section of the building. The washrooms and change rooms will be improved to include accessibility features. Rink A and the washrooms and change rooms in the new section of the building will remain open throughout the project.

  • Spring 2022: Hire a design team
  • Summer 2022: Design development
  • Fall 2022: Detailed design
  • Winter 2022: Hire a construction team
  • Late April 2025: Construction starts, rink B closes

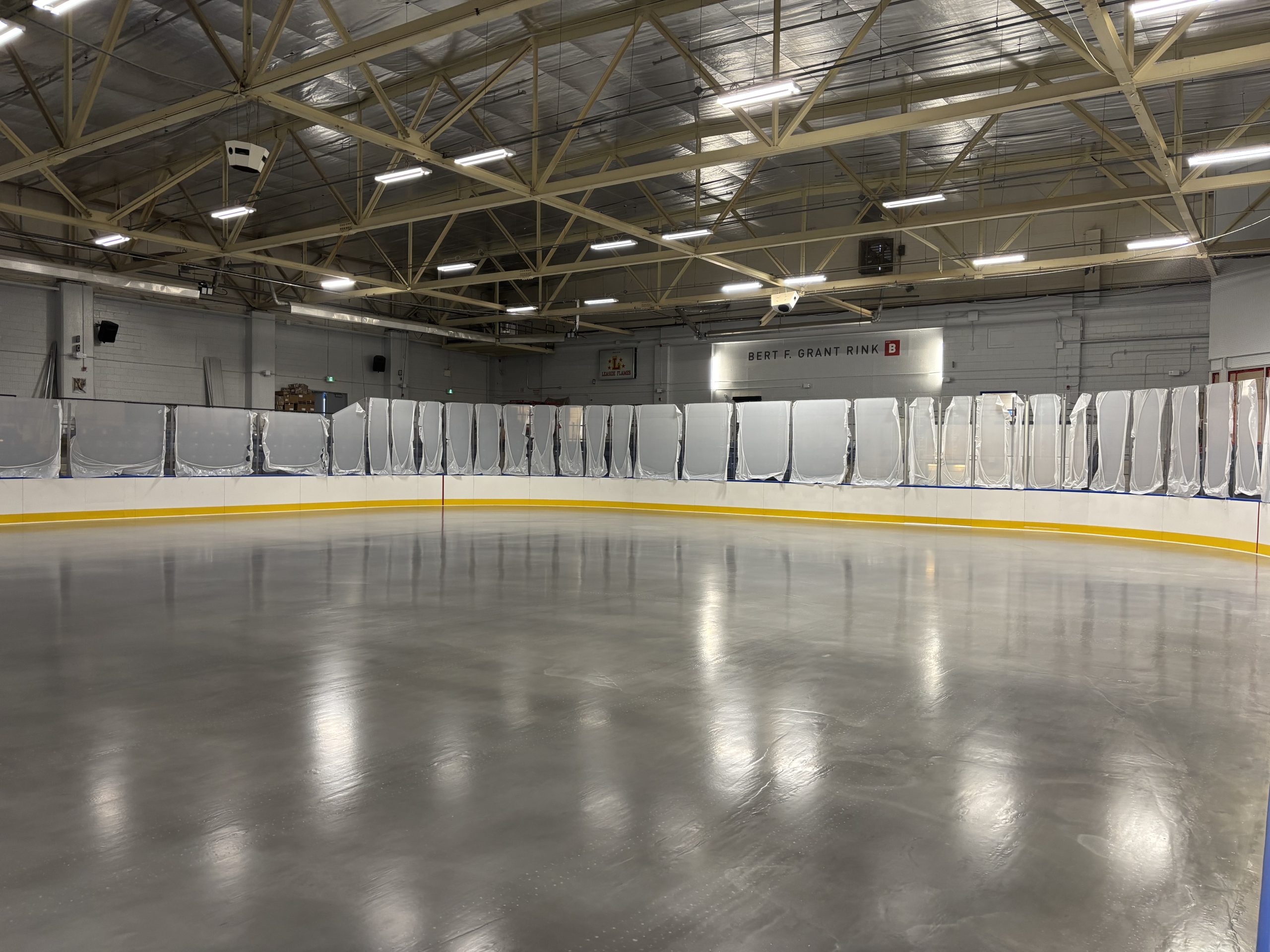

  • Early January 2026: Construction complete, rink B reopens

The timeline is subject to change.

November 2025

Construction Update

Construction is progressing with the installation of a new refrigeration system, as well as mechanical and electrical systems. Architectural finishes are being added in the washrooms and dressing rooms, along with a few remaining items for roof installation. Improvements to the banquet hall and snack bar have been completed.

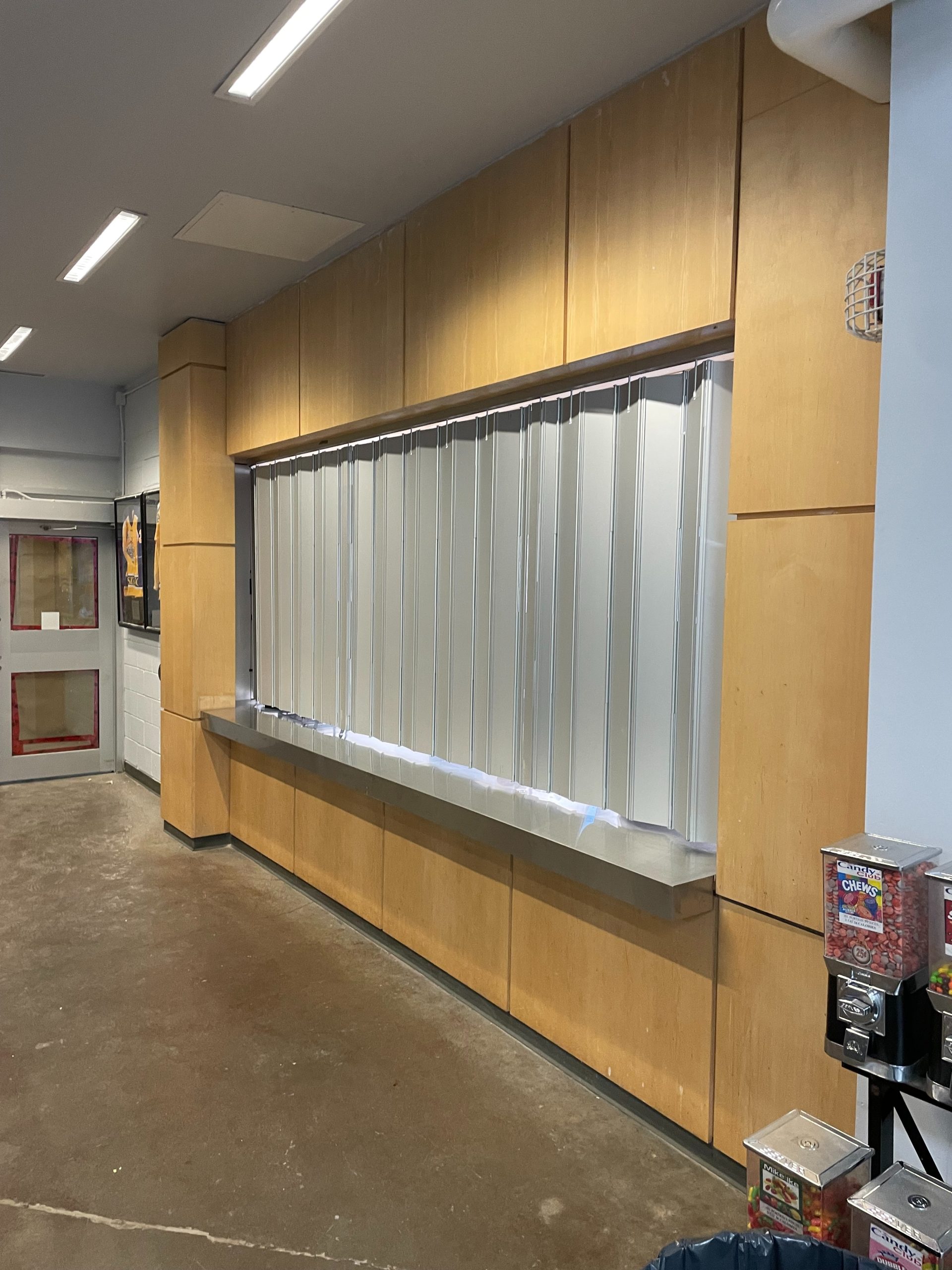

Snack bar counter with a closed metal shutter in a hallway. The counter is framed by light wood paneling, and the floor is polished concrete. Overhead fluorescent lights illuminate the space.

Large banquet hall with a polished wooden floor and white walls. The ceiling has recessed panels and built-in lighting. Chairs are lined up along the perimeter of the room, and a few tables are placed against the walls. The room is empty and well-lit.

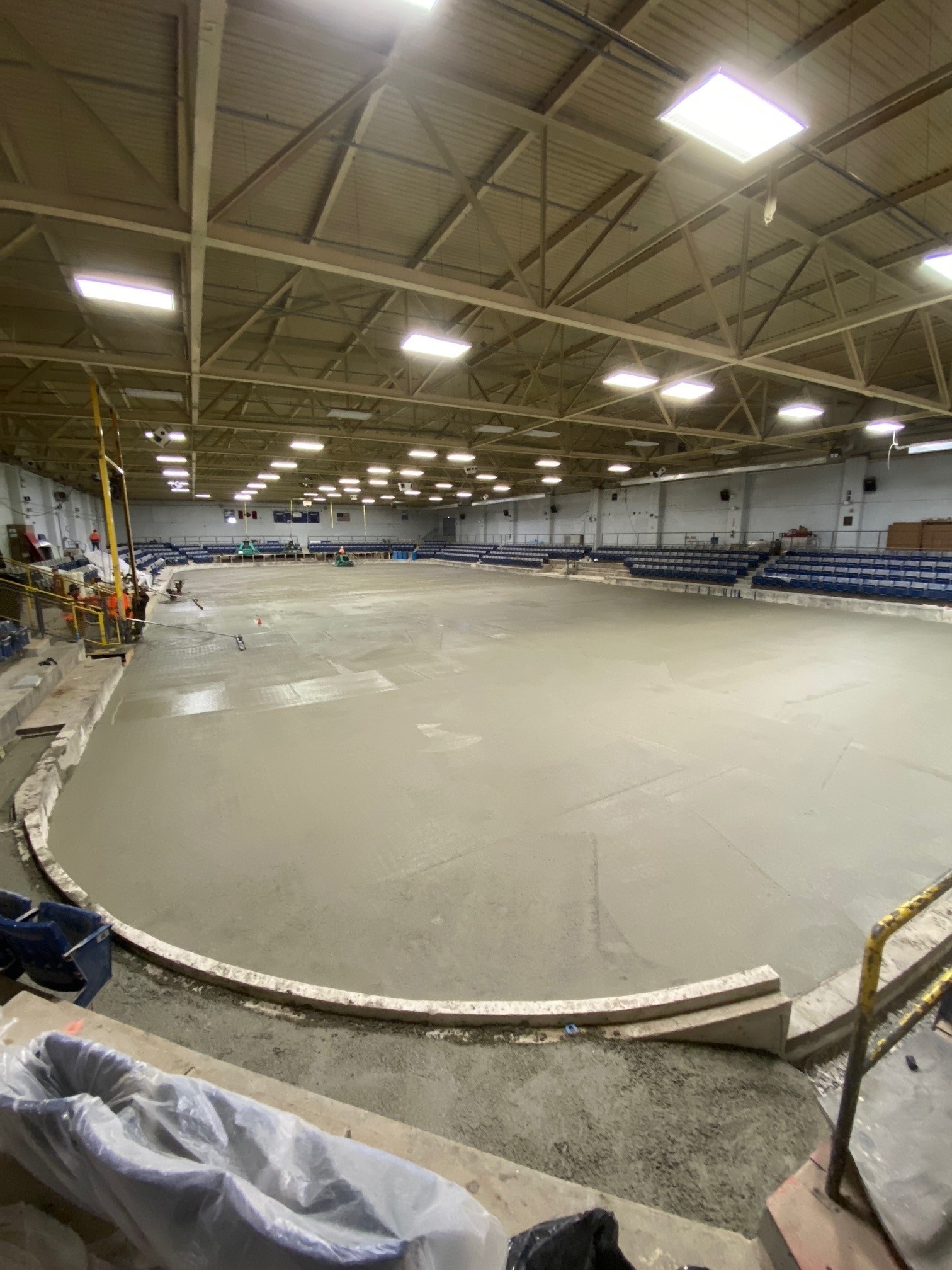

Indoor arena under construction with a freshly poured concrete floor. The space is large with high ceilings supported by exposed metal beams and bright overhead lights. Blue seating sections surround the arena.

September 2025

Construction Update

The existing rink slab and refrigeration system have been removed, and installation of the new refrigeration lines and system is in progress. Mechanical, electrical and architectural finishes are advancing throughout the building, including the banquet hall, washrooms and snack bar. The roof structure has been reinforced, and roofing is nearing completion.

The indoor ice rink under construction, with the rink slab removed to show a dirt ground. A construction vehicle is idle by one side. Brick walls and blue bleacher seats, some covered in plastic sheets, surround the rink.

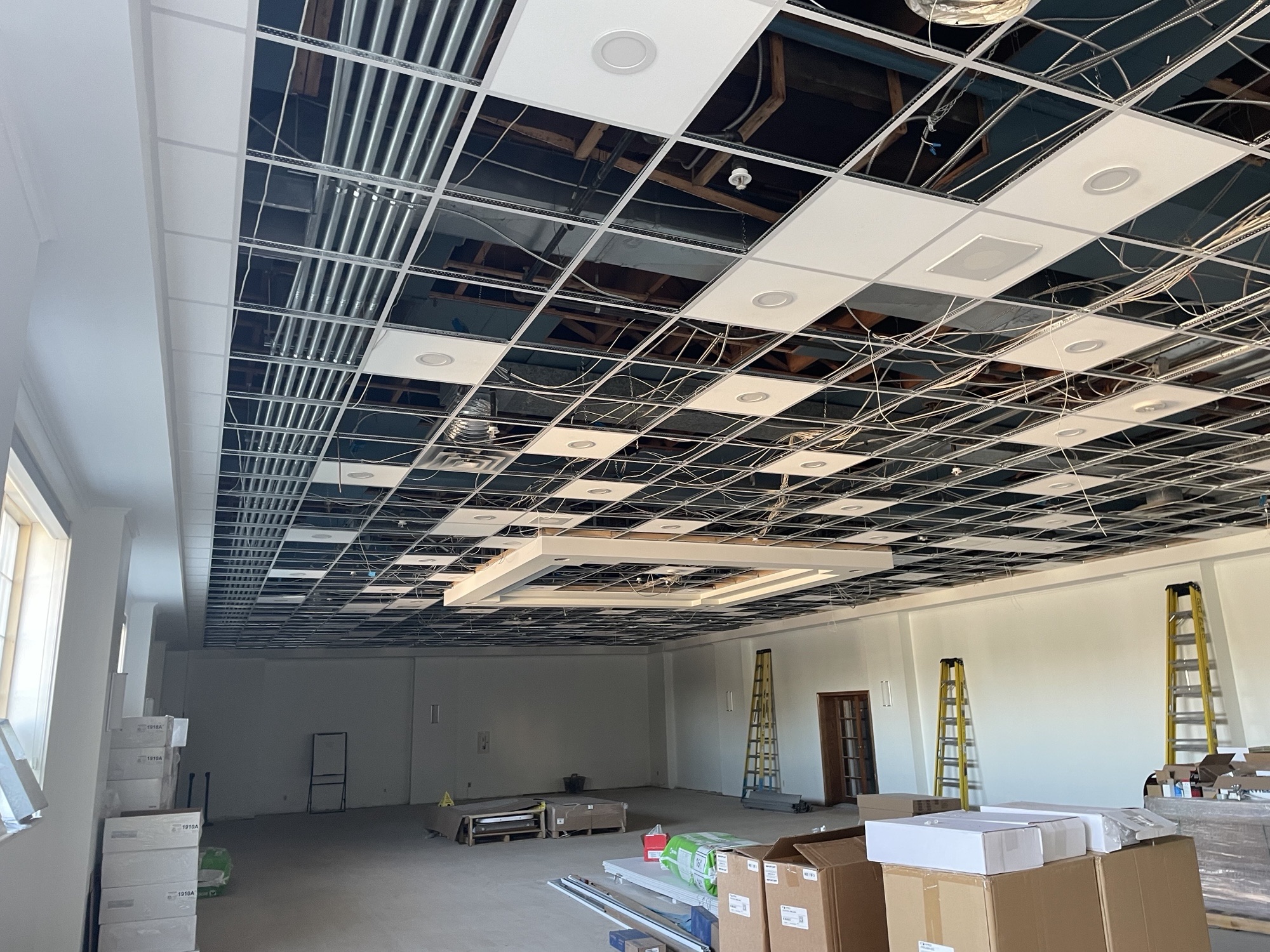

The banquet hall under construction. Wires, ducts and light fixtures span the ceiling and are visible between the partially installed ceiling panels. Boxes, pallets and ladders are scattered around the room.

May 2025

Construction Update

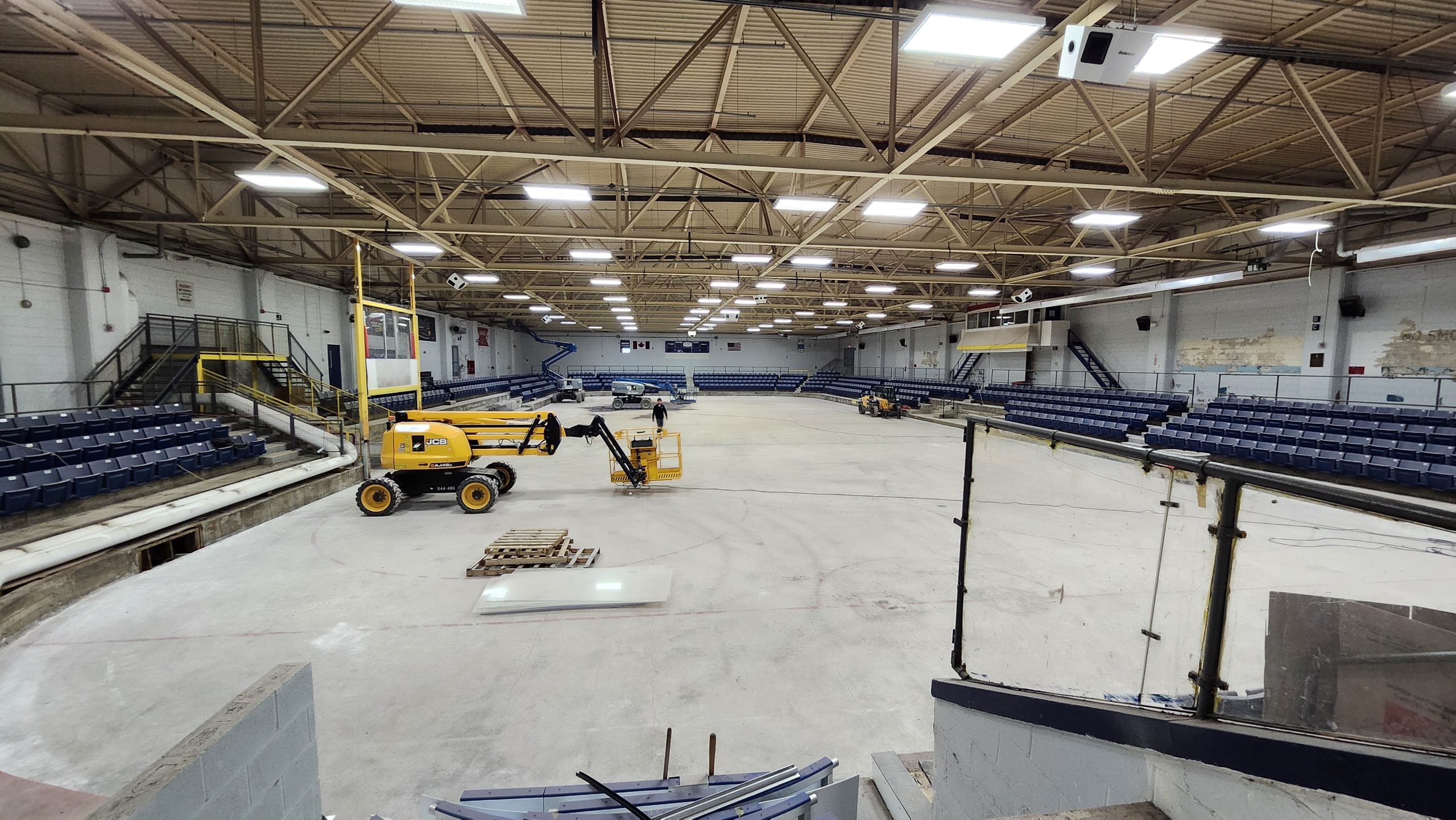

Construction on rink B is underway and progressing on schedule. The dasher boards have been removed, and reinforcement of the existing roof trusses is ongoing. Work on the trusses is expected to be completed by the end of June. Demolition of the rink slab will follow.

A wide-angle view of an indoor ice rink under construction with the ice surface removed. Construction equipment including several lifts and wooden pallets are scattered across the concrete rink floor.

March 2025

Rink Roof Replacement Starts

Construction to replace the roof over rink B has started and is expected to be completed by the end of April 2025.

Spring 2023

The design phase is completed and construction is anticipated to start in 2025.

Summer/Fall 2022

A design team has been hired and are confirming the project scope in preparation for detailed design later this fall.
