George Bell Arena opened in 1961 and includes an indoor ice rink, mechanical and electrical rooms, change rooms, washrooms, and office spaces. The City is improving the roof and some of the building’s components to ensure the facility is in a state of good repair.

  • October 2023: Hire a consultant and preliminary schematic design
  • December 2023 to July 2024: Develop schematic and detailed design
  • August 2024 to March 2025: Hire a construction team
  • May 2025: Construction starts, facility closes
  • September 2026: Construction complete, facility reopens

The timeline is subject to change.

June 2026

Roof installation over the arena is about 75 per cent complete. Installation of washroom fixtures is ongoing in washrooms and dressing rooms. Rubber flooring has started in dressing rooms, and radiator installation is complete.

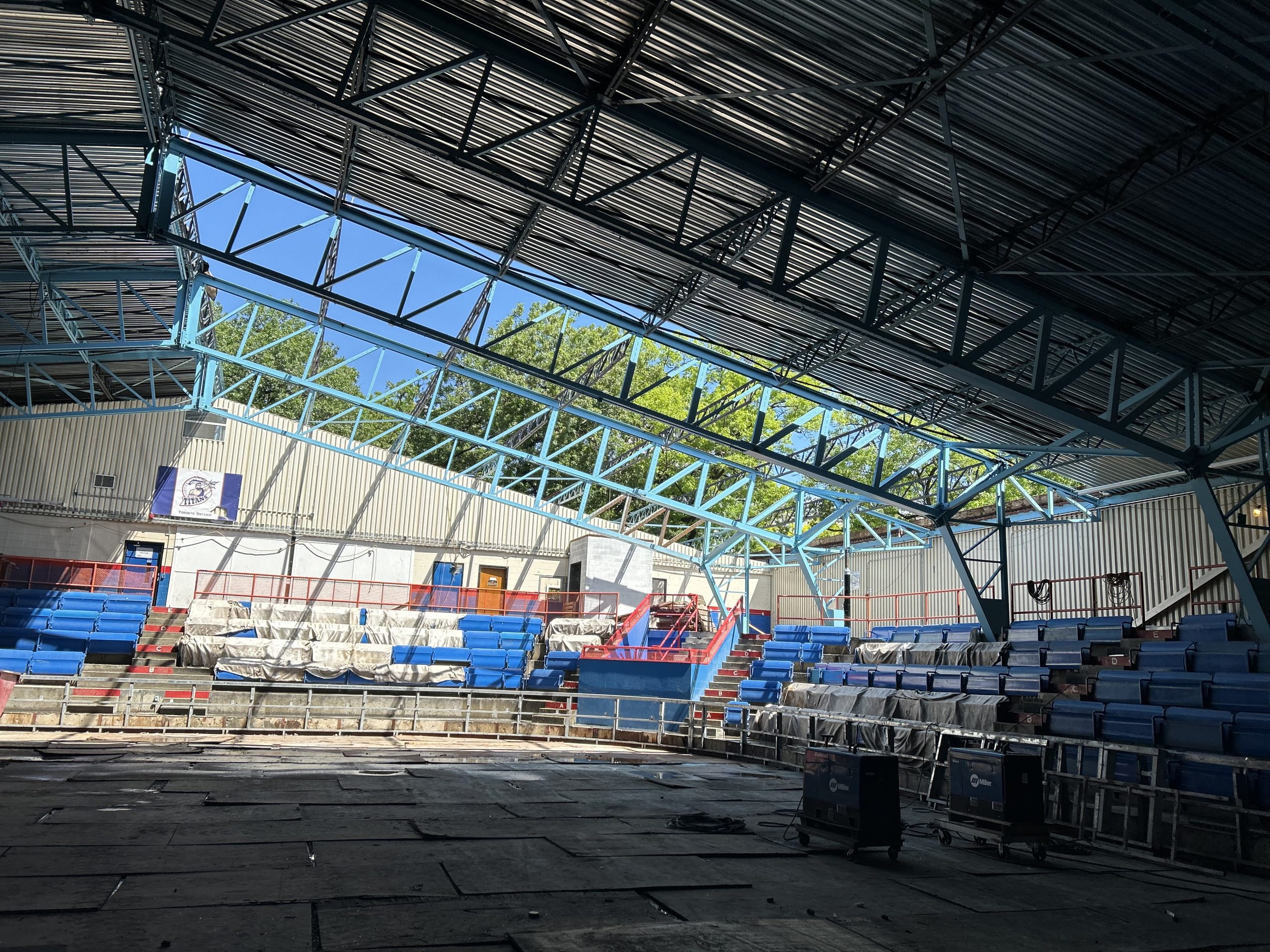

The rink in George Bell Arena under construction, showing the ongoing roof installation. Blue steel trusses support the roof, which is mostly in place except for one open section. Blue bleachers surround the unfinished rink surface where construction equipment is visible.

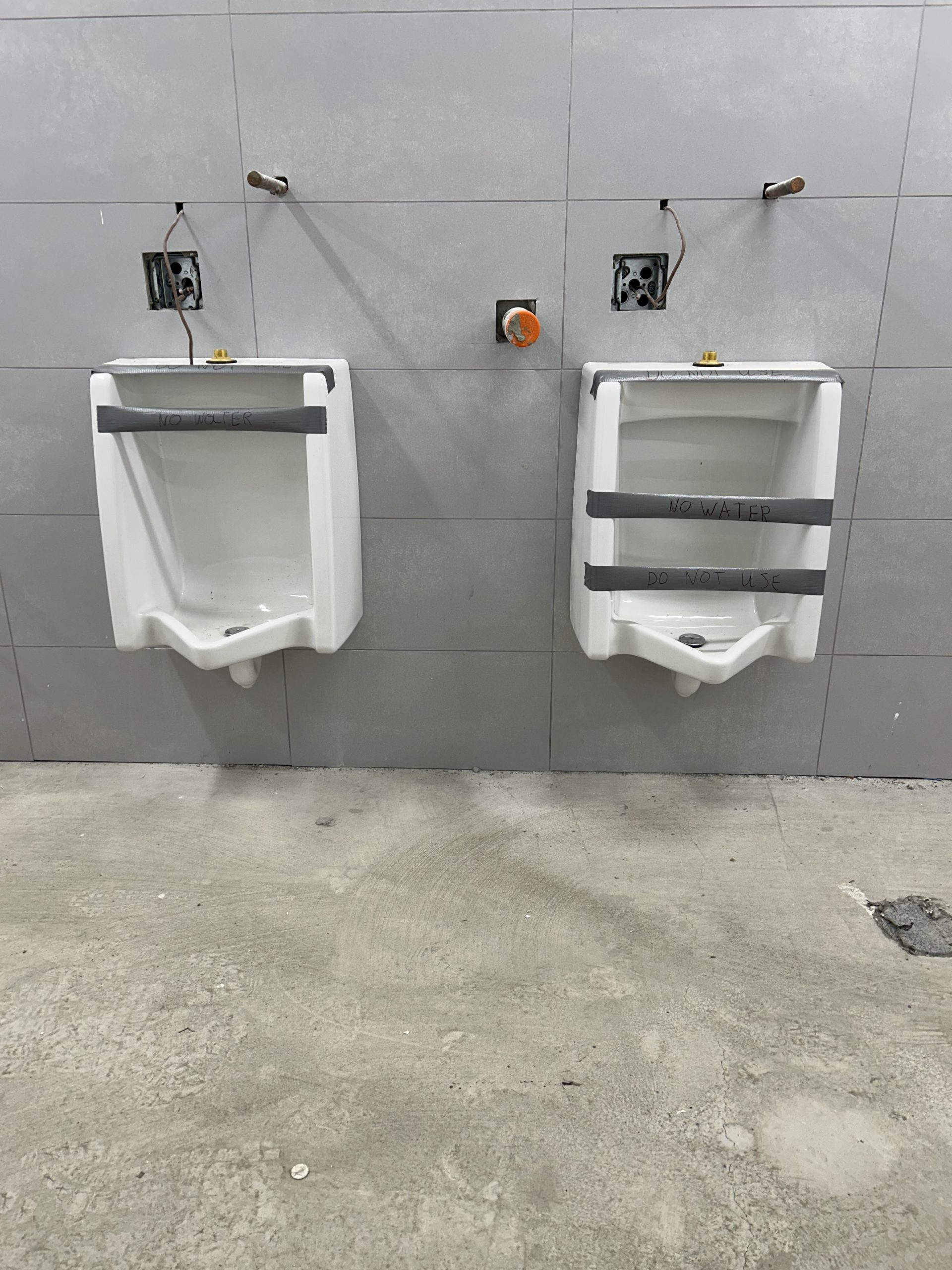

Two taped off urinals installed against a grey tiled wall. Plumbing and electrical connections remain unfinished above the urinals. The concrete floor is unfinished.

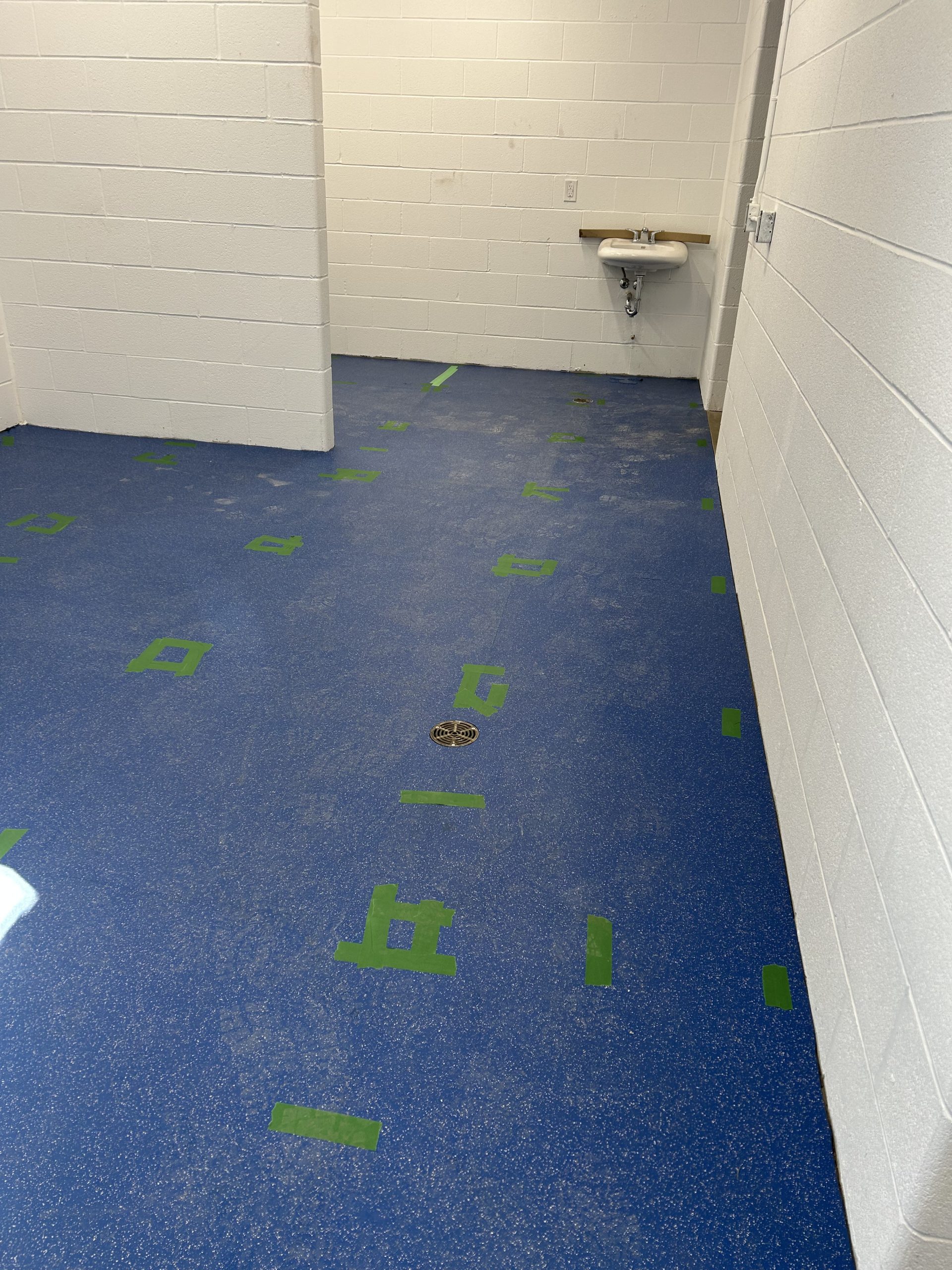

A dressing room in George Bell Arena with white block walls and blue speckled floors. Strips of green tape mark spots on the blue speckled floor. A small sink is mounted on the wall at the far end.

May 2026

Roof installation over the arena is 65 per cent complete and progressing well. Masonry work is ongoing to fill wall openings where radiators are being installed. Radiator installation is mostly complete. Rubber flooring is expected to start next.

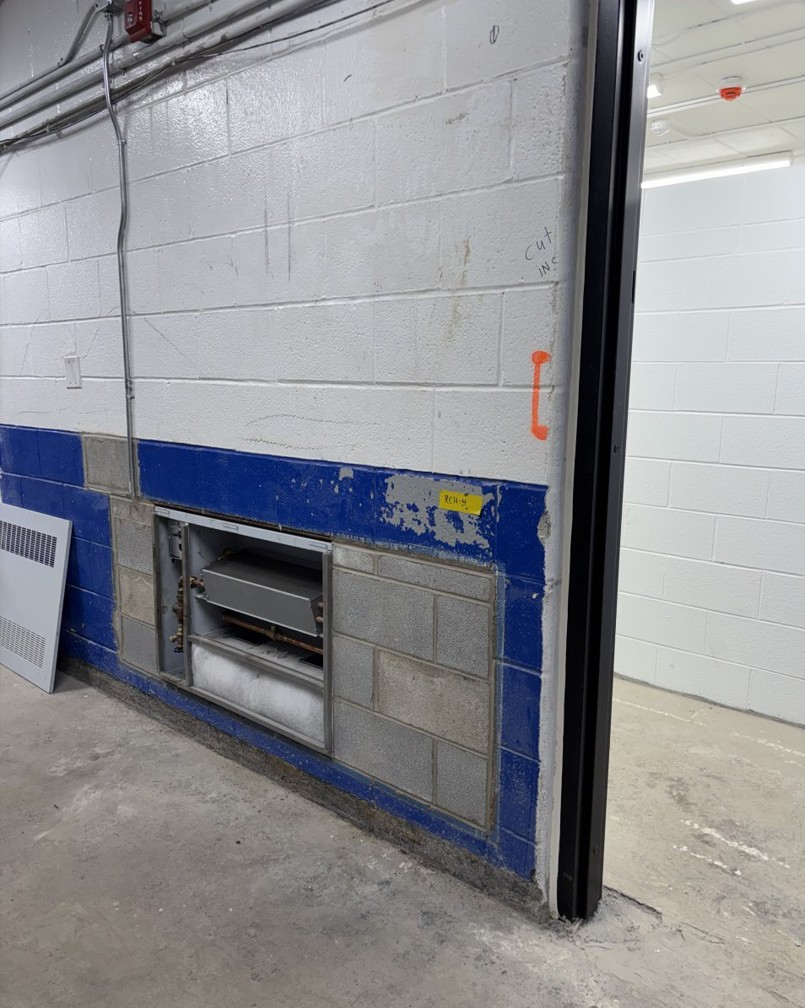

View of a block wall in George Bell Arena. The lower half of the wall is partially painted in blue and has an opening where radiator parts have been installed. Electrical wiring runs along the top of the wall.

April 2026

Installation of radiators and washroom fixtures is ongoing. Roof demolition over the rink continues. Demolition work in the mechanical room beneath the roof is mostly complete. Installation of the new roof above the arena is about 50 per cent complete.

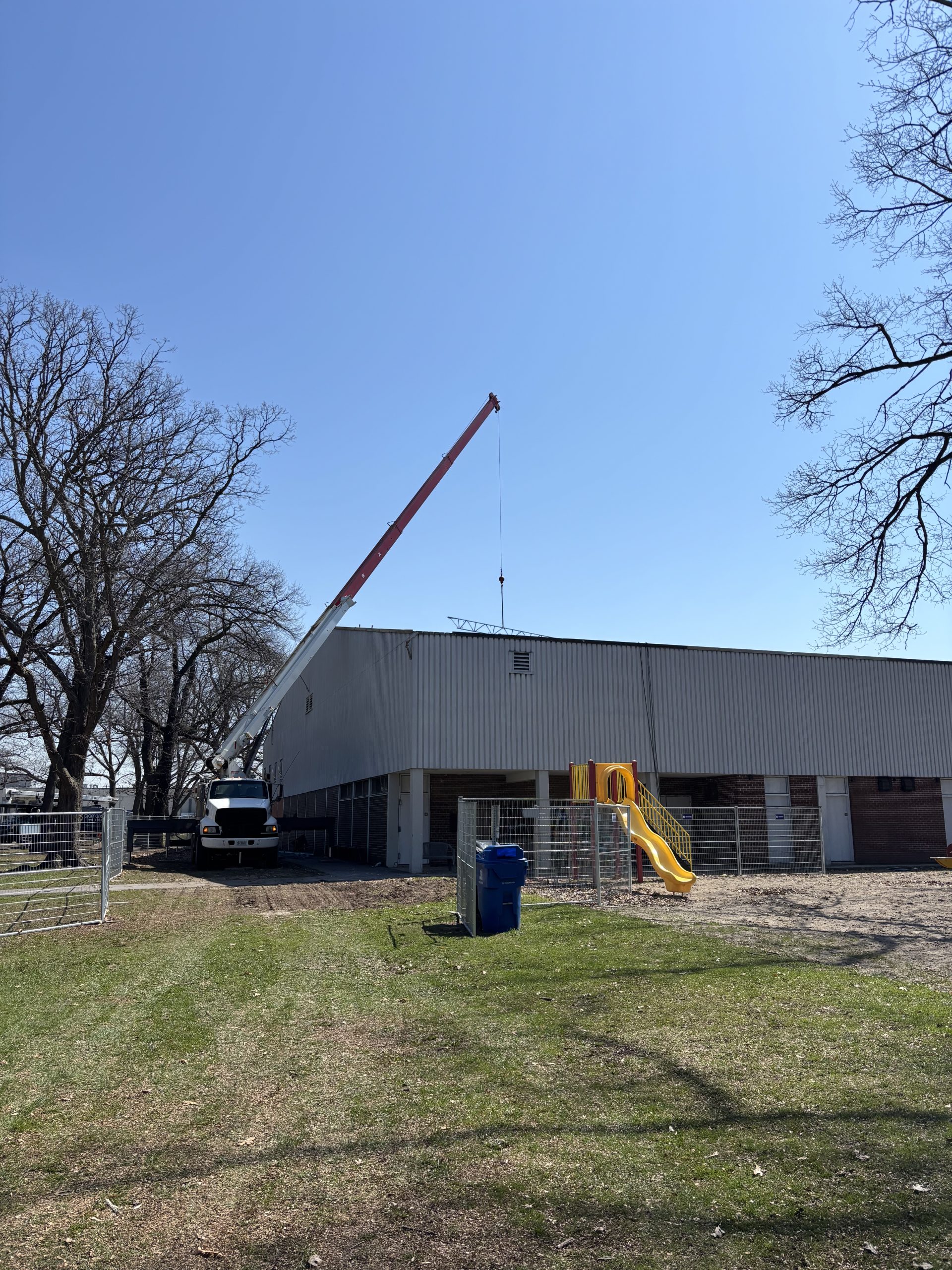

George Bell Arena viewed from the outside on a clear day. A truck with a crane is parked by the building, which is partially surrounded by safety fencing. The nearby area includes grass fields, trees and a small play structure.

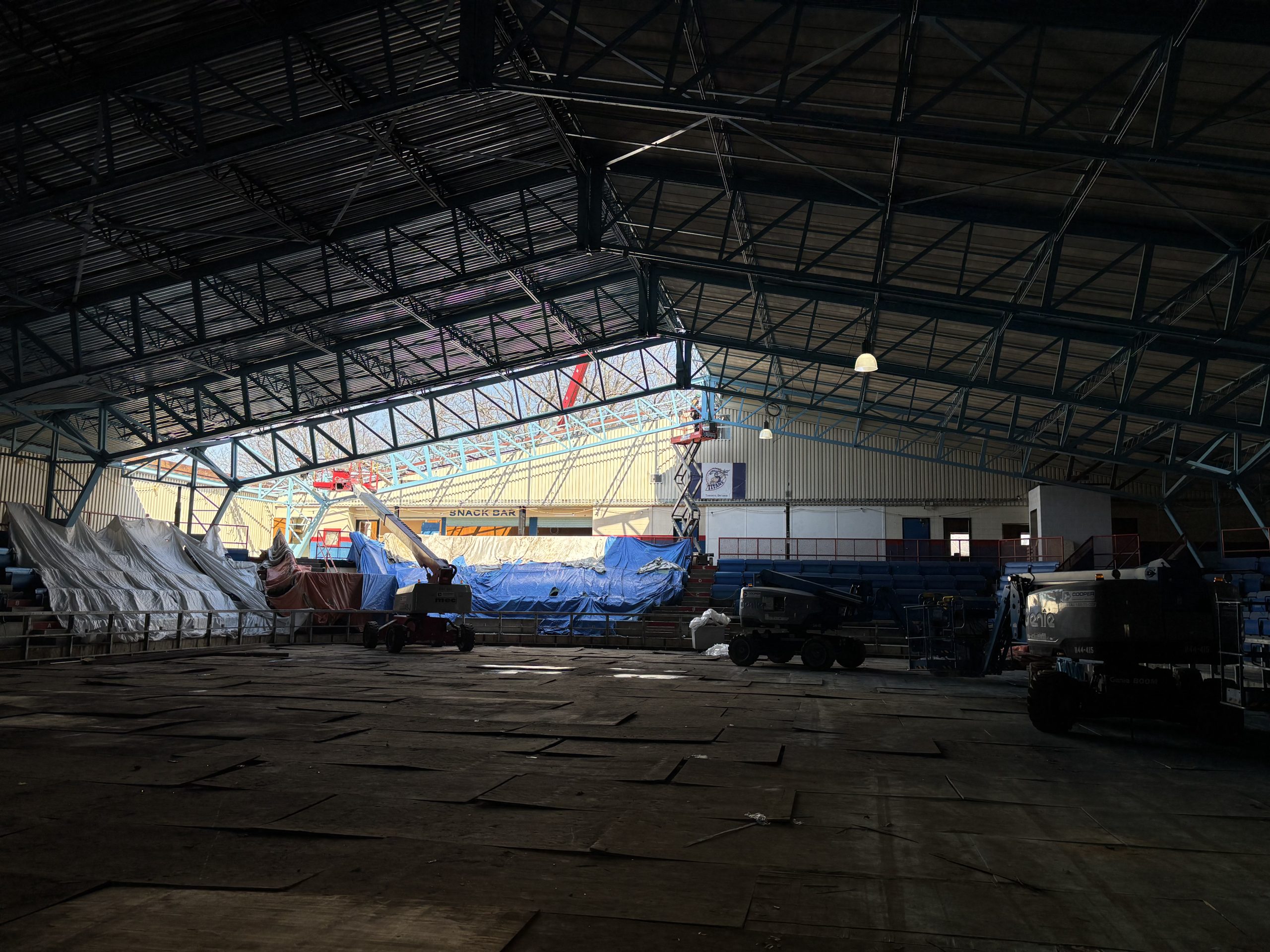

The rink in George Bell Arena under construction. Steel beams span the ceiling and a section of the roof is open, letting in natural light. The rest of the space is dim. Construction equipment and materials are piled on one end.

March 2026

Wall painting and steel joist installation are ongoing. Crews are also installing exterior doors, windows, and the second-floor elevator shaft walls. Interior lighting and metal doors are mostly done. Roof demolition over the rink has started and is about 25 per cent complete, with metal decking and insulation installation following close behind.

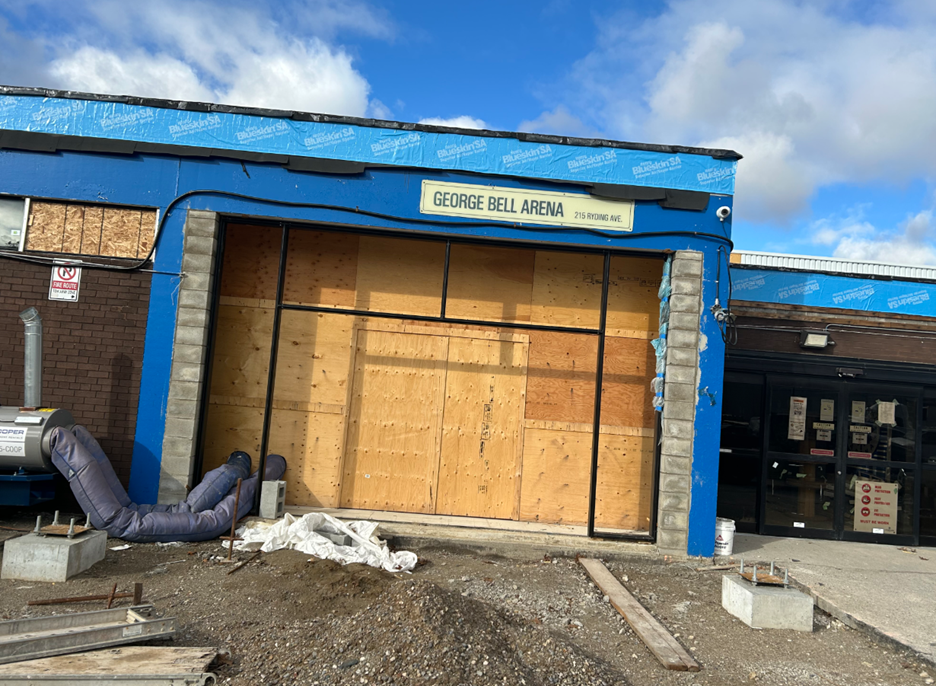

Exterior of George Bell Arena at 215 Ryding Avenue, showing a boarded-up entrance under construction with plywood panels, blue weather barrier wrap, and construction materials on the ground.

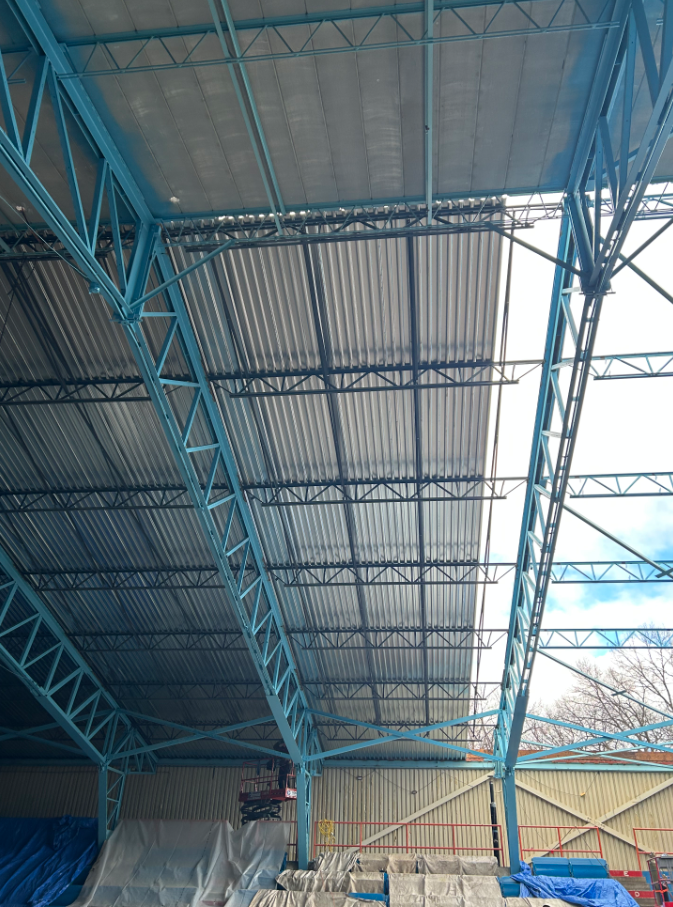

Interior view of a large open-air structure's roof under construction, showing exposed blue steel trusses and metal roof decking against a partly cloudy sky.

January 2026

Interior lighting, pipe insulation, metal doors, wall painting and steel joist painting are ongoing. Cap sheet installation on the flat roof and wall tiling in washrooms and dressing rooms are mostly done. Footings and column bases at the canopy, masonry walls around the elevator pit and machine room, and the penalty box concrete floor are complete.

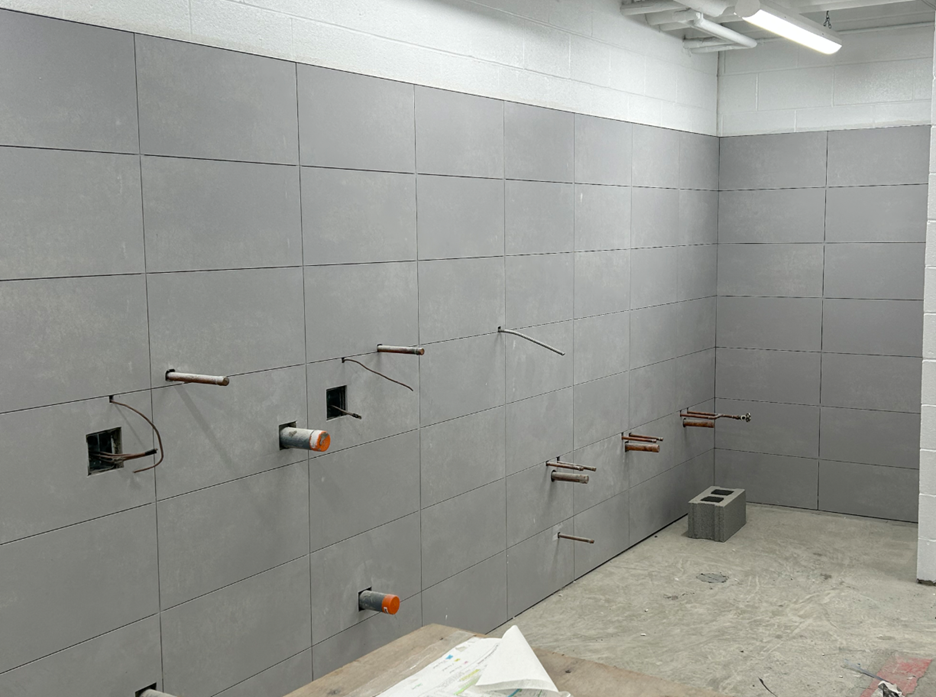

Partially completed grey tiled wall in an interior space with several plumbing pipes and electrical conduits protruding from the surface, alongside a concrete block on the floor.

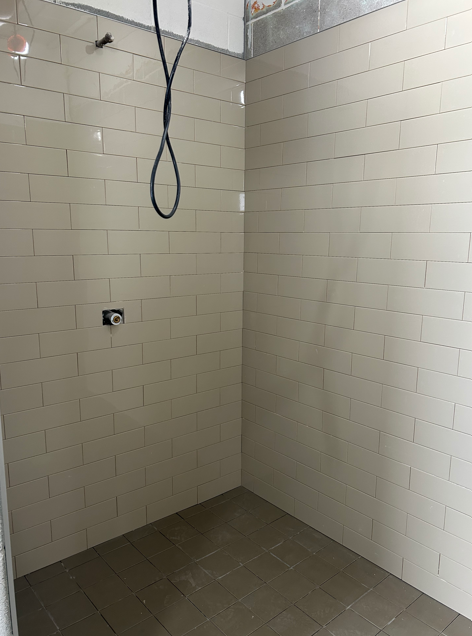

Completed shower stall with light beige subway tile walls and dark grey tile flooring, with an electrical outlet and hanging wire visible.

December 2025

Electrical wiring, cap sheet installation, new parapets, steel roof reinforcement, pipe insulation and painting are ongoing. Metal door frames at interior and exterior locations are mostly done. Footing reinforcement at the entrance canopy, and concrete work for the elevator pit and sump pit, are complete. Wall tiling in washrooms has started.

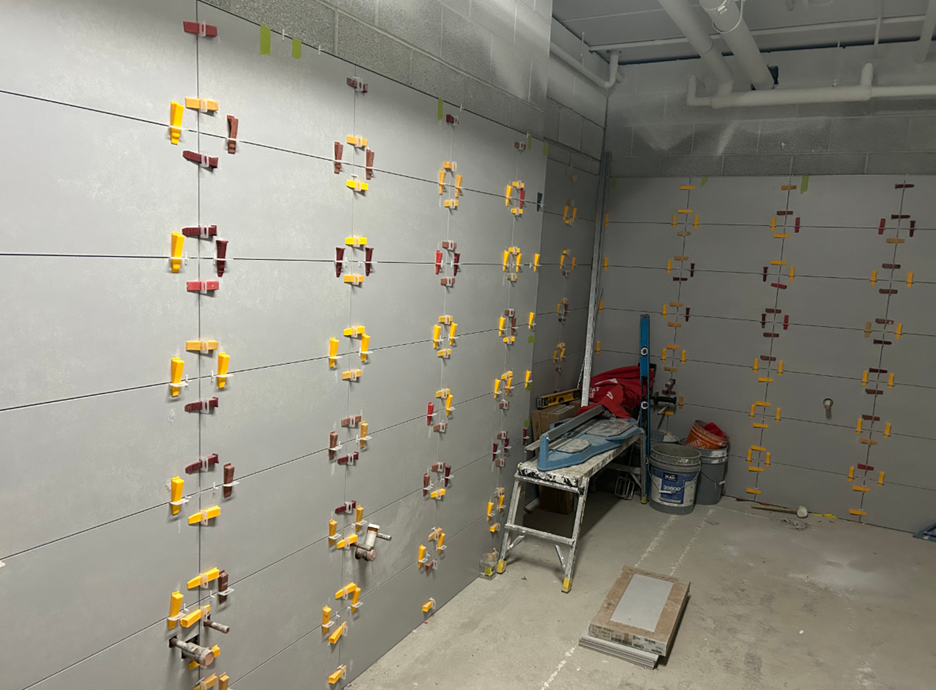

Interior construction site with grey tile spacers and leveling clips installed across three unfinished tiled walls, a ladder, tile-cutting tool, and building materials on the floor.

November 2025

Interior painting started and progressed well. Installation of the new sump pit was completed. Door frame installation advanced, and work on roof parapets and cap sheet at flat roofs continued.

October 2025

Demolition to create the new entrance opening was finalized. Installation of new canopy footings commenced, and flat roof installation continued to progress. Work on the new elevator sump pit advanced, while roof structure reinforcement over the arena began and moved forward steadily. Installation of electrical panels was also in progress.

September 2025

Installation of the flat roof began and progressed well. Demolition of brick facing at the new entrance was completed. Interior roof drain installation moved forward, along with plumbing fittings and pipe insulation. Enlargement of the access pathway to the arena was underway. Masonry blockwork was largely completed, and electrical rough-in continued.

August 2025

Backfilling of trenches for below-slab drainage was completed, and new concrete was installed to cover all slab cuts. Door openings at washrooms and dressing rooms were enlarged, with new lintels installed. Work on concrete block partitions and infill at existing openings advanced, while electrical and plumbing rough-ins continued.

June 2025

Construction continues and is anticipated to be completed in September 2026. Demolition of the washroom and changing room walls is in progress. Floor protection has been installed over the existing rink slab.

The existing rink slab overlaid with the installed floor protection made of wooden panels. Exposed metal trusses support the ceiling and extend from the bleachers surrounding the rink.

May 2025

Construction starts and the facility closes to the public.

The existing George Bell Arena, viewed from the side. Safety fencing is installed around the building perimeter.

March 2025

A construction team is hired for the project.

November 2024

The City started the process of hiring a construction team for the project.

February 2024

Design work is progressing and is anticipated to be completed in summer 2024.

November 2023

A consultant is hired for the project.

July 2023

The City started the process of hiring an engineering consultant to provide design, engineering, and contract administration services for the project.

June 2023

On June 1, the facility re-opened. Hockey associations and contract holders that typically use the arena will be operating their 2023/2024 ice season as usual from September 2023 to March/April 2024.

May 2023

The City reviewed the final engineering report which noted that the roof required replacement within two years. The report allowed the facility to reopen in June 2023.

December 2022

Unplanned closure of the facility for additional engineering investigation and physical testing of the facility roof. The City worked closely with the Arena Board of Management to relocate ice user groups for the spring and summer season.

The arena improvements will include:

  • Removal, replacement and refurbishment of the roof structure and the roofing system
  • Upgrades to the public washrooms and changing rooms
  • Upgrades to the building’s mechanical and electrical system
  • Accessibility improvements within the facility and at the parking lot
  • Upgrades to flooring and lighting
  • Upgrades to the refrigeration system

The arena will be closed during construction.
