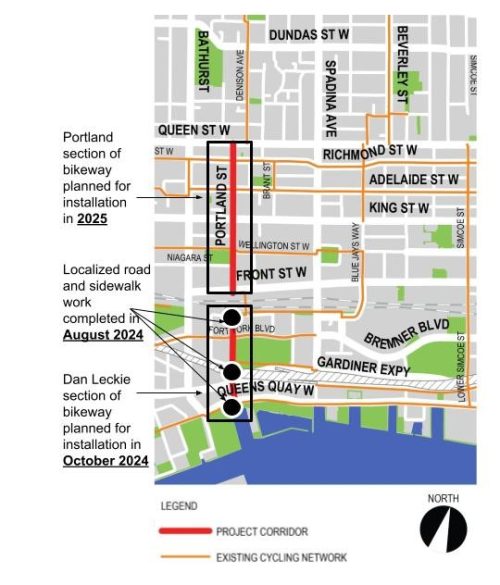

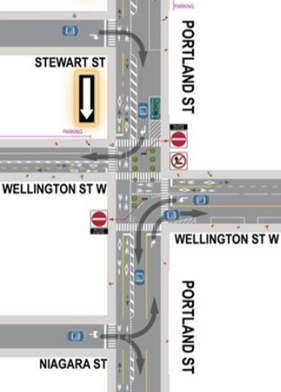

Installation of the Portland Street Neighbourhood Traffic Improvements and Bikeway between Queen Street and Front Street is planned for the week of April 30th (weather dependent). Please see details on the Installation Notice. For details on navigating the new one-way segments, please see the new Portland Street map.
The City of Toronto has approved a new cycling route along Portland Street – across the Puente De Luz pedestrian/cycling bridge – and down Dan Leckie Way. This project is part of the Council-approved Cycling Network Plan for 2024 and will provide a safe cycling route connecting our City’s waterfront with the bustling and rapidly growing fashion district and provides traffic calming measures to reduce neighbourhood traffic infiltration.
The portion of the Portland-Dan Leckie bikeway on Portland Street from Queen Street to Front Street, is planned for installation starting the week of April 30th 2026 (weather dependent). Installation notice can be seen here. Installation Notice
Key changes include:
Based on public feedback, the block of Portland Street from Wellington Street to Front Street will remain two-way for motor vehicles.
The Portland Street portion is postponed to open in Spring 2026, following Fall 2025 traffic signal changes.
The portion of the Portland-Dan Leckie bikeway on Dan Leckie Way from Queen’s Wharf Road to Fort York Boulevard, is planned for installation starting October 14th, 2024. Construction notice can be seen here. Installation Notice
Key changes include:
Three concrete sidewalks support the bikeway were completed in August 2024. The portion of the bikeway on Portland Street is planned to be installed in 2025 to accommodate the construction of the King/Bathurst Ontario Line Station.
The full project was originally planned for installation in 2024. In order to better accommodate active construction for the Ontario Line King/Bathurst Station, installation of the Portland Street segment of the project will be postponed until 2025.
The City continues to work with Metrolinx and Deputy Mayor Malik’s office to minimize the impacts of the Ontario Line construction on the community. This delay also means that establishments on Portland Street with CafeTO patios will be able to make full use of the 2024 season.
The Dan-Leckie section of the project is still planned for installation in 2024 and an installation notice will be mailed to all local addresses in advance with anticipated dates, impacts and details.
Some associated sidewalk work to accommodate cycling ramps will begin in August at the following locations:
City Council approved the installation of bikeways on Dan Leckie Way from Queens Quay West to Queens Wharf Road and Portland Street from Queen Street West to Front Street West (bi-directional cycle track). A copy of the staff report is available at IE12.4.
Based on public feedback, the project team updated the cycle track design. These updates were shared at a virtual public meeting on Tuesday, January 23rd (6:30 – 8 p.m.).
In 2024, the Dan Leckie segment of the Portland-Dan Leckie project was installed as planned, but the Portland segment was deferred to accommodate the heaviest volume of construction vehicles using Portland Street for a hauling route during excavation for the King/Bathurst Ontario Line Station. This heaviest hauling period was completed in December 2025, as such the Portland bikeway is planned for installation in spring 2026. Signal work associated with the project is already underway.
The City has been closely monitoring the traffic impacts of several recent development projects in the area. Most recently, the development of The Well, expected to be a generator of 22,000 trips per day is now fully operational and has not impacted local motor vehicle volumes on Wellington or Portland Street. Transit and transportation option investments including RapidTO Bathurst, the Ontario Line and safe and intuitive cycling infrastructure are an integral part of transportation planning to sustainably accommodate growing populations.
The Portland street bikeway and traffic improvements is part of an integrated transportation plan to minimize neighbourhood traffic infiltration. The introduction of one-way streets and the diverter at Portland and Wellington make Portland a local-traffic only route which will no longer act as a cut-through route between Front Street to Queen Street. Preliminary findings show that RapidTO Bathurst has not substantially increased volumes on neighbourhood streets, and work continues to address adjustments at intersections to improve traffic flow along Bathurst Street. The Portland bikeway and new neighbourhood traffic patterns will be well established before the 2027 King Street streetcar track work commences.
Community members have requested some degree of traffic management at the off-set intersection of Portland Street and Wellington Street for several years. Given the heavy pedestrian volumes at this intersection connecting to Denison Square Park, and cycling volumes expected to increase with the introduction of the Portland bikeway, as well as existing issues around safety, confusion and traffic volumes on neighbourhood streets, the diverter was proposed to address all of these issues by minimizing the number of motor vehicle movements at this intersection and reducing non-local traffic through the neighbourhood. Emergency vehicles will still be able to traverse through the diverter. The diverter is made of modular materials including planters and flexible signage, and will be closely monitored should any adjustments be required.

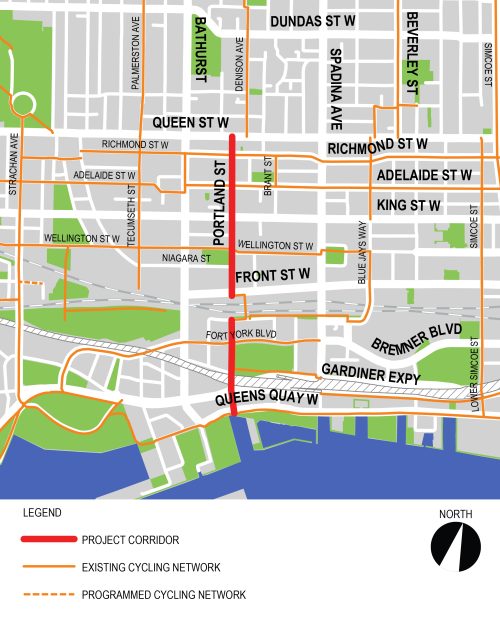

The project area extends along Portland Street from Queen Street to Front Street, across the Puente de Luz Bridge, and along Dan Leckie Way from Queens Wharf Road to the Martin Goodman Trail.
Following public consultation, the design for this segment has been revised. Please see Project Updates above.

In this section the City is proposing:

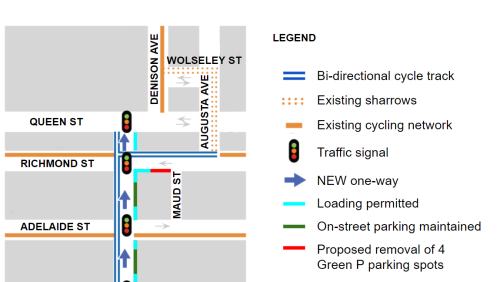

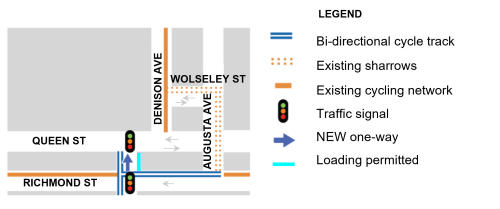

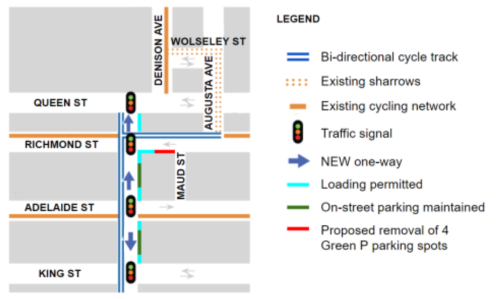

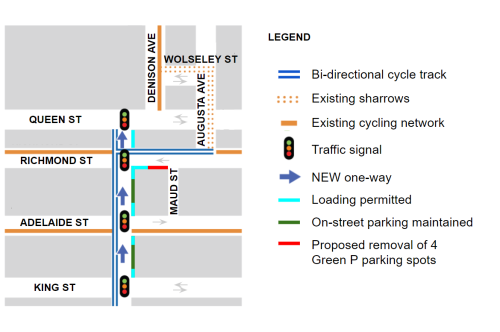

Based on public feedback, the Northbound one-way segment of Portland Street will extend from Adelaide Street to Queen Street.

In this section the City is proposing:
Following public consultation, the design for this segment has been revised. Please see Project Updates above.

In this section the City is proposing:

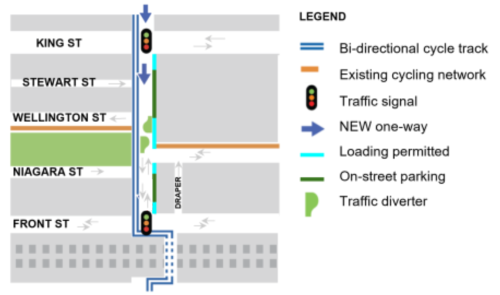

Based on public feedback, the block of Portland Street from Niagara Street to Front Street will remain two-way circulation for motor vehicles
Following public consultation, the design for this segment has been revised. Please see Project Updates above.

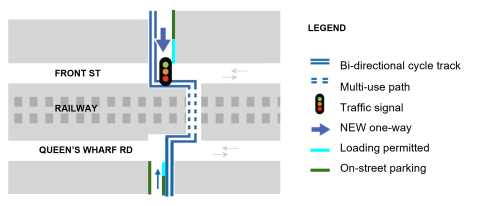

The bridge will connect the north and south segments of the Portland – Dan Leckie bikeway. Cyclists must yield to pedestrians while crossing the bridge.
Following public consultation, the design for this segment has been revised. Please see Project Updates above.

In this section the City is proposing:
Following public consultation, the design for this segment has been revised. Please see Project Updates above.

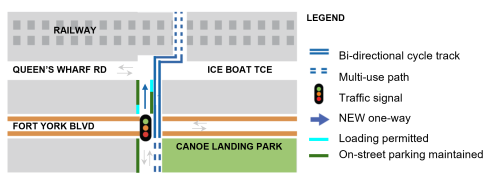

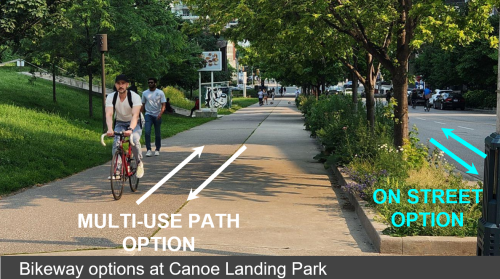

There are two options under consideration for the bikeway from Fort York Boulevard to Lake Shore Boulevard:
Option 1 – share existing multi-use path
Option 2 – continue on-street (Dan Leckie Way)
Please note that the the formal consultation period is now closed.
Virtual Public Meeting
The City of Toronto invited community members to a virtual meeting on January 23rd, 2024 learn about how the design was updated based on community feedback. Attendees had the opportunity watch a presentation and ask the project team questions.
Public Consultation
The City of Toronto invited residents to a public Drop-In event on October 16, 2023 to learn more about the project and provide feedback about the proposed changes on Portland Street and Dan leckie Way.
Attendees had the opportunity to view the project information panels and speak with members of the project team one-on-one.
A survey received 1300 + responses.
Insights from the survey and all consultation events can be found in the consultation report:
