The process for designing and developing parks and recreation facilities can change based on the size and complexity of each project. The following sections are generally listed in the order in which the design and development process happens, from early planning through to construction.

A project is commonly initiated in three ways:

  • from a development project
  • from a new park opportunity
  • from a planned capital project on existing parks and recreation facilities

A project team typically includes City staff, consultants, contractors and other specialists depending on a project’s specific needs.

A new park from a development project

When new buildings are developed, the City requires the developer to provide either:

  • land for new parks
  • a payment – called cash-in-lieu of parkland, which is used by the City to buy land for parks and to build and improve parks and recreation facilities

The City forms an agreement with the developer, who, with guidance from the City, hires consultants to work with the community and stakeholders in planning and designing the park, then hires contractors to build it.

A new park opportunity

The City may create a new park or expand an existing one by buying land or converting land already owned by the City, such as a road or parking lot.

City staff review and prioritize these opportunities based on criteria in Council-approved policies and strategies. This includes looking at the need for parkland, how the space connects to other parks or open spaces, equity and other factors.

Before moving forward, the City checks that the land is safe and suitable for park use. This may include environmental investigations. Once the land is approved as a future park and any impacts are understood, the City hires consultants to work with the community and stakeholders to plan and design the park or facility. Contractors are then hired to build it.

A planned capital project on an existing parks and recreation facility

These projects are outlined in the Parks and Recreation Annual Capital Budget and Nine-Year Capital Plan. The City hires consultants to work with the community and stakeholders in planning and designing the park or facility and then hires contractors to build it.

The capital program includes a wide range of projects, such as:

  • Designing and building new recreation facilities
  • Renovating existing facilities and infrastructure
  • Developing and improving parks, greenspaces and amenities
  • Carrying out environment and landscape improvements

This phase can take six months to a year. The project team prepares everything needed to make sure the project runs smoothly.

This may include:

  • Gathering and reviewing important background information about the park or facility and the nearby area, like its:
  • Checking the site’s condition, including:
    • what is currently there
    • how the space is used
    • the land’s shape
    • environmental tests
    • soil and water testing
    • archaeological studies, as needed
  • Pre-engagement with:
    • the local Councillor
    • City staff
    • area stakeholders (like Residents’ Associations, community groups or Business Improvement Areas)
    • the community
    • Indigenous rights holders, if appropriate.

    For park or facility improvements, this usually involves identifying the challenges and opportunities that are driving the need for change (also called ‘drivers of change’).

  • A Request for Proposal (RFP) to hire a design consultant and other services, if needed (like a community engagement consultant, heritage specialists or engineers). This process includes:
    • creating and releasing the RFP
    • reviewing and evaluating all proposals
    • negotiating contracts
    • awarding the contract
    • starting the project
  • Installing signs to inform the community about the project and upcoming engagement events.

This phase can take three months to a year. The design consultant conducts more inventory and analysis of the site to confirm or build on initial findings. The rest of the phase focuses on community engagement, where the project team gathers input from the community and stakeholders about the park or facility design.

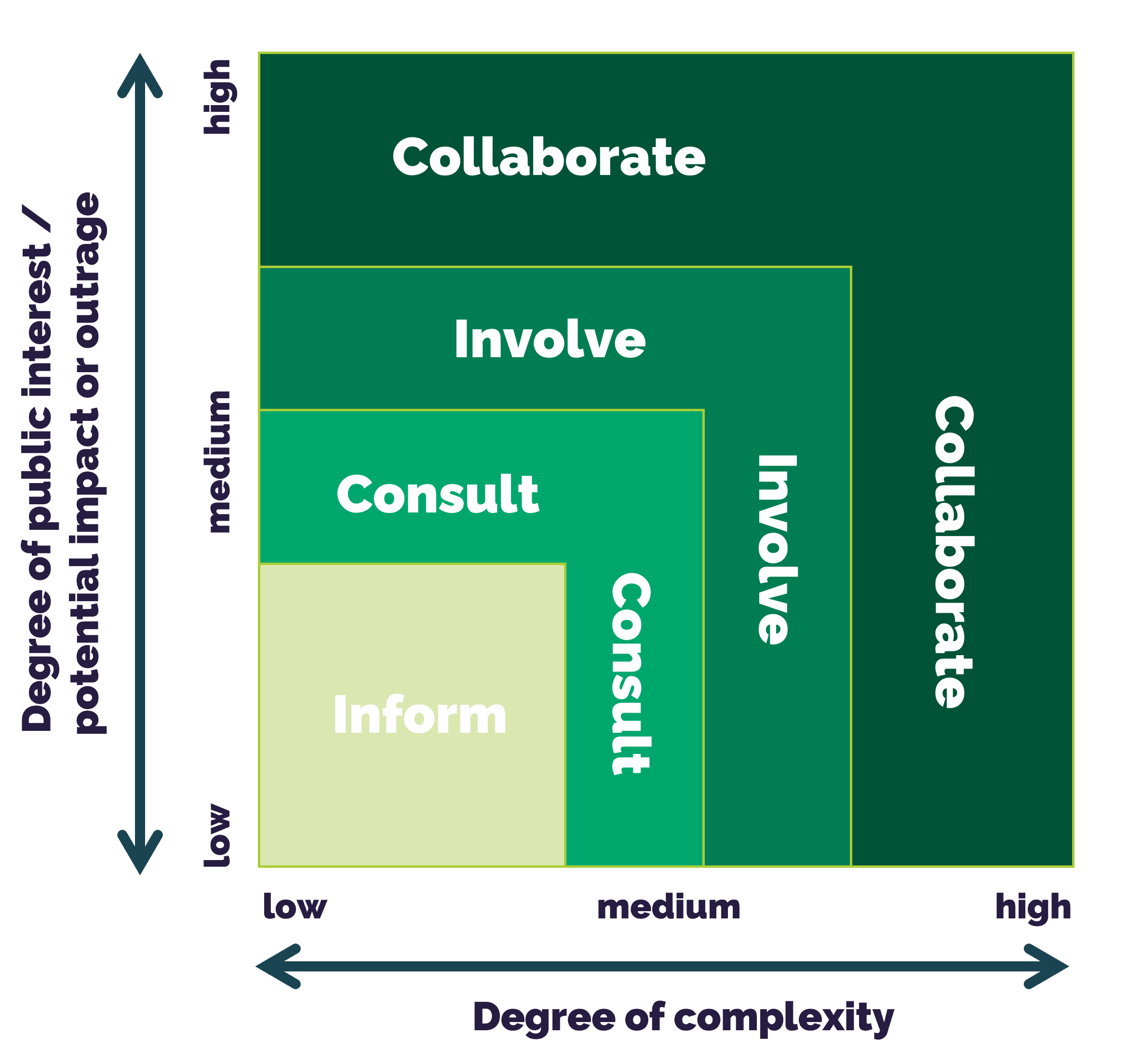

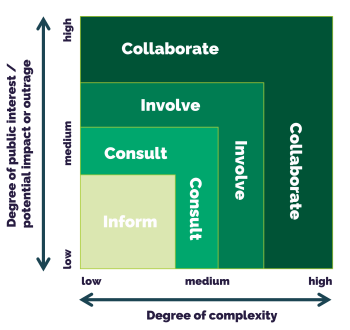

A chart visualizing the relationship between the degree of public interest/potential impact or outrage (vertical axis) and the degree of complexity (horizontal axis) in community engagement. The chart is divided into sections labeled "Inform," "Consult," "Involve," and "Collaborate," with increasing levels of public involvement as both interest and complexity rise. "Inform" is at the bottom left (low complexity, low public interest), while "Collaborate" is at the top right (high complexity, high public interest). The City uses a framework based on the International Association for Public Participation Spectrum to decide how to engage the community in projects. This framework assigns a level of engagement to each project: Inform, Consult, Involve or Collaborate. The appropriate level is determined by the project’s size, complexity, budget, and the public’s interest and potential impact. A tailored engagement plan is then created to align with the chosen level of engagement and the project’s needs.

The community design process usually includes three standard phases of engagement. Depending on the project, some phases might be changed or left out. Feedback is collected through various methods, including surveys, meetings, workshops, advisory groups, open houses and pop-up events. These are promoted through multiple channels, such as the project webpage, on-site signs, social media and email updates.

Community Engagement Phase 1: Towards a Vision

The project team works with the community and stakeholders to create:

  • A vision statement that describes the community’s ideal future park or facility. It is a broad, inspiring statement that unites everyone around the project’s overall goals.
  • Guiding principles that reflect the community’s key values and ideas about the park or facility’s look and feel. They clarify the vision statement and guide the design by describing the desired outcomes.
  • Big moves that identify the main design priorities for the park or facility. They offer specific directions that help steer the initial design work towards achieving the vision statement and guiding principles.

Community Engagement Phase 2: Exploring Design Options

Design options for the park or facility are developed from feedback collected in the previous engagement phase. Depending on the level of engagement, these are either developed directly with the community and stakeholders in a workshop or by the project team. The design options are then presented to the community and stakeholders to gather their thoughts, including whether they align with the vision statement, guiding principles and big moves.

Community Engagement Phase 3: Setting the Direction

The project team uses feedback from the previous engagement phases to develop a preferred design for the park or facility. This design is then presented to the community and stakeholders for their confirmation and input before it is finalized.

Depending on the level of engagement, this phase is also called Communicating the Direction. The preferred design is shared with the community and stakeholders on the project webpage and through other communication channels.

This phase can take three months to a year. The design consultant works with the City (and the developer, if applicable) to create detailed drawings and plans based on the preferred design from Community Engagement Phase 3.

This work may include:

  • Layouts and drawings of the park or facility
  • A list of materials and finishes
  • A plan for managing stormwater and other environmental factors
  • Plans for planting trees and landscaping
  • Cost estimates for the project
  • Additional design work needed for specific requirements and approvals, which might involve presentations to groups like the Design Review Panel and the Accessibility Advisory Committee

Additionally, signs are typically installed in the park or facility to provide information about the project and the anticipated construction timeline.

This phase can take three months to a year. The design consultant works with the City (and the developer, if applicable) to prepare all working drawings and specifications. These detailed documents provide instructions for building the project and are necessary for issuing the project for tender, which invites qualified contractors to submit bids for constructing the park or facility.

Once the project is ready, the City or the developer (after getting City approval) issues a Request for Quotations (RFQ). They review and evaluate all submitted bids and select the contractor who will complete the construction.

Additionally, signs are typically installed in the park or facility to provide information about the project and the anticipated construction timeline.

This phase can take six months to over a year. During this time, the contractor builds the park or facility, while the City and the design consultant (and the developer, if applicable) oversee the work. Before construction starts, the City approves the contractor’s plan and ensures it is followed throughout the process.

Construction usually begins with:

  • Installing construction fencing around the site
  • Updating on-site signs to inform the community about the construction schedule
  • Installing tree protection fencing and the contractor’s trailer, if needed

An area of the site is set aside for construction materials.

For new parks built as part of a development project, the process may look a little different, as they are often within an area already enclosed by construction hoarding. Throughout construction, the City and the design consultant monitor the work to ensure it complies with Ministry of Health and Safety requirements and City bylaws.

Once construction is complete, the new park is handed over to the City for maintenance and operation, and a standard warranty period begins. A walk-through is conducted with the City, the design consultant, the contractor and the developer (if applicable) when the project is finished and again one year later.

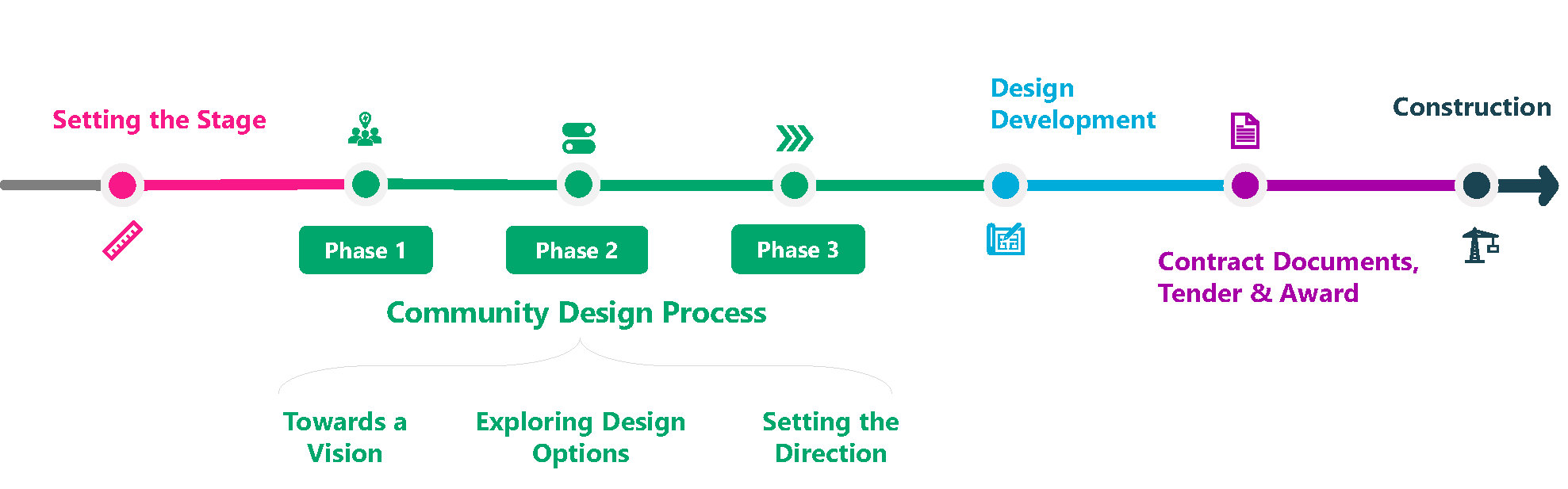

A visual overview of the park and recreation facility design and development process. It is further described in the caption following the image.
The diagram includes five main stages: Setting the Stage; Community Design Process; Design Development; Construction Documents, Tender and Award; and Construction. The Community Design Process is further divided into Towards a Vision, Exploring Design Options and Setting the Direction, although not every project will have all three.
