The City of Toronto has approved the first on-street cycling facilities within the Weston neighbourhood. Weston Cycling Connections will connect local destinations within the community and neighbouring areas, and enhance safe, active mobility options for residents.

May 2024 Update

In May, 2024 the City installed bike lanes, shared lane markings, and other road safety improvements on Pine Street from Church Street to Wright Avenue, on Wright Avenue from Pine Street to Sam Frustaglio Drive, and on Sam Frustaglio Drive from Wright Avenue to Denison Road East. View the Installation Notice for more details.

Weston Cycling Connections will take place over three phases:

  • Phase 1: North-south cycling connections approved to be installed in spring 2024 from Denison Road East to Church Street
  • Phase 2: East-west cycling connections proposed to be installed in 2025 from the Humber River Recreational Trail to the Rustic and Maple Leaf neighbourhoods, to Trethewey Drive, and to the Weston GO station (public consultation expected to take place in late 2024)
  • Phase 3: North-west connections proposed to be installed in 2026 to Weston Road and crossing Highway 401 to Wilson Avenue (public consultation expected to take place in 2025)

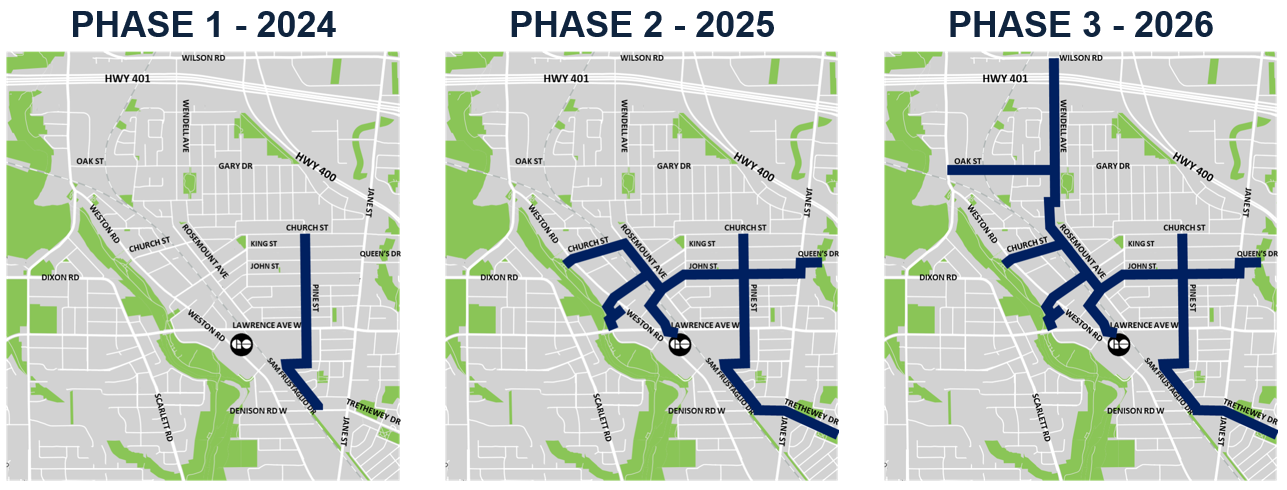

Three maps showing Weston Cycling Connections routes for Phases 1, 2, and 3

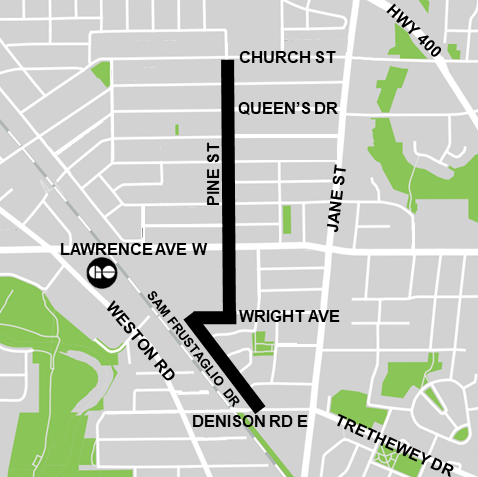

Phase 1 Project Area

The following streets were approved by City Council for cycling facilities in Phase 1, for installation in spring 2024:

  • Pine Street – Church Street to Wright Avenue
  • Wright Avenue – Pine Street to Sam Frustaglio Drive
  • Sam Frustaglio Drive – Wright Avenue to Denison Road East

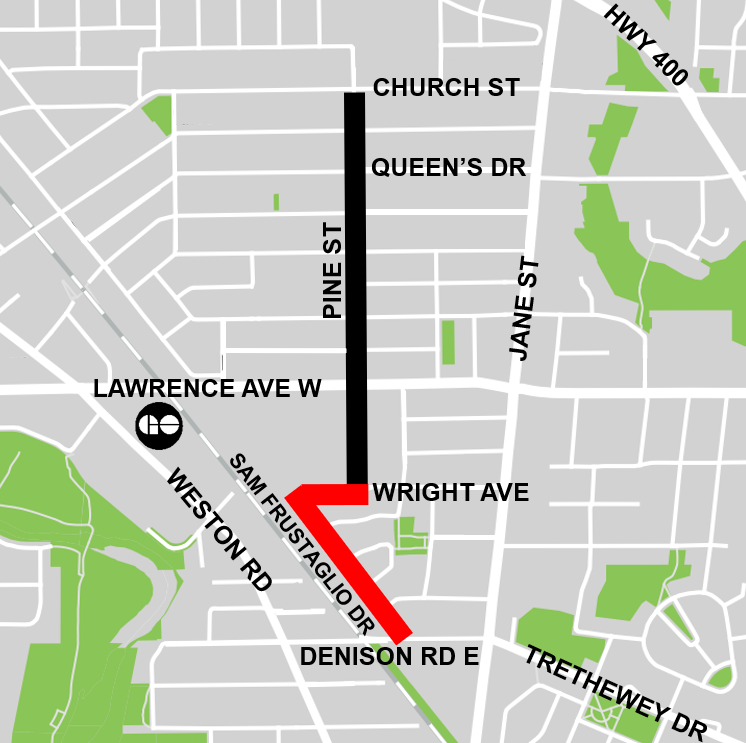

Map of Weston Cycling Connections project area, highlighting proposed Phase 1 cycling facilities along Pine Street, Wright Avenue, and Sam Frustaglio Drive

Phase 2 Project Area

Phase 2 will focus on connections from the Humber River Recreational Trail to the Maple Leaf and Rustic Neighbourhoods, to Trethewey Drive, and to the Weston GO Station.

Map of project area from Highway 401 to Trethewey Drive and Jane Street to Weston Road. Highlighting the Humber River Recreational Trail to the Maple Leaf and Rustic Neighbourhoods, to Trethewey Drive, and to the Weston GO Station.

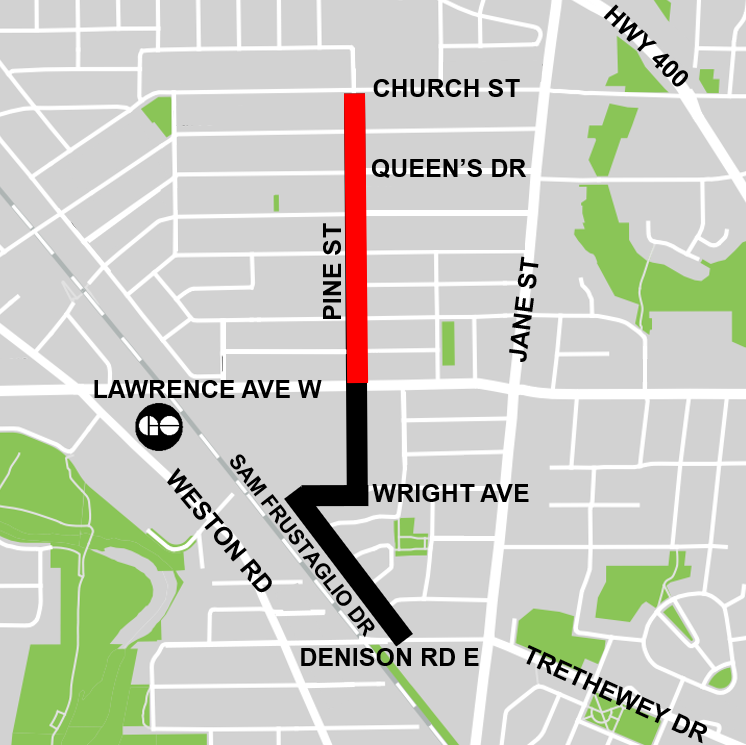

Map of Weston Cycling Connections project area, highlighting proposed Phase 1 cycling facilities along Pine Street from Lawrence Avenue West to Church Street

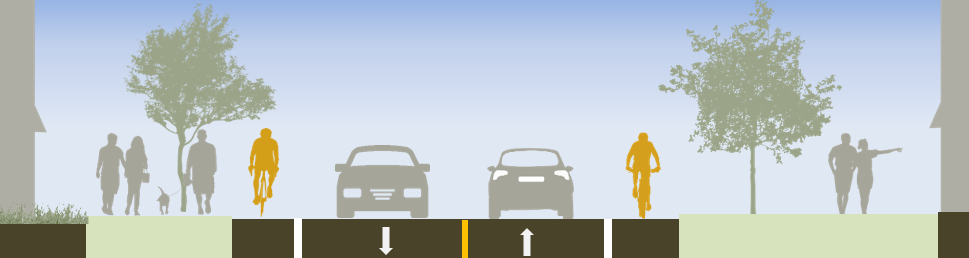

For Pine Street from Lawrence Avenue West to Church Street, the following design has been approved to improve safety for people cycling and predictability for people driving by providing clear separation from motor vehicle lanes.

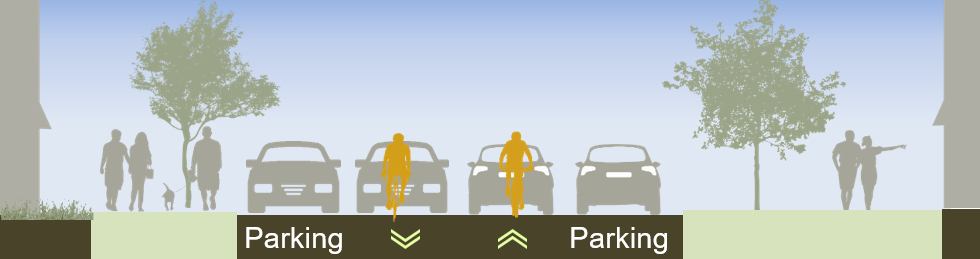

Approved changes:

  • Bike lanes in both directions, except:
    • Southbound shared lane markings for one block between Church Street and King Street to accommodate existing on-street parking on the west side of the street
    • Southbound shared lane markings in front of Weston Collegiate Institute to accommodate the existing school bus loading zone on the west side of the street
  • Removal of existing on-street parking on one block between King Street and Queen’s Drive
  • New zebra markings (stripes) at existing pedestrian crossings between Church Street and Lawrence Avenue West

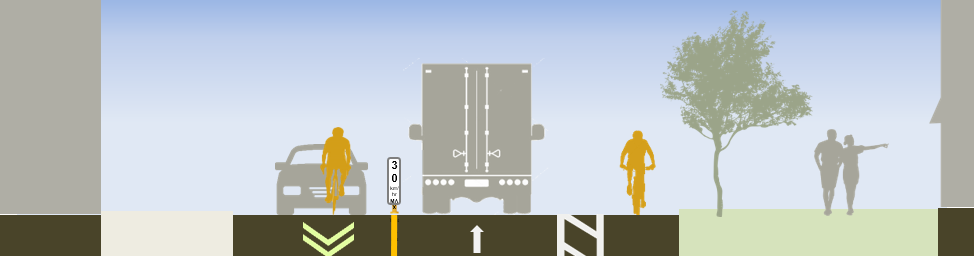

Cross-section of Option 1

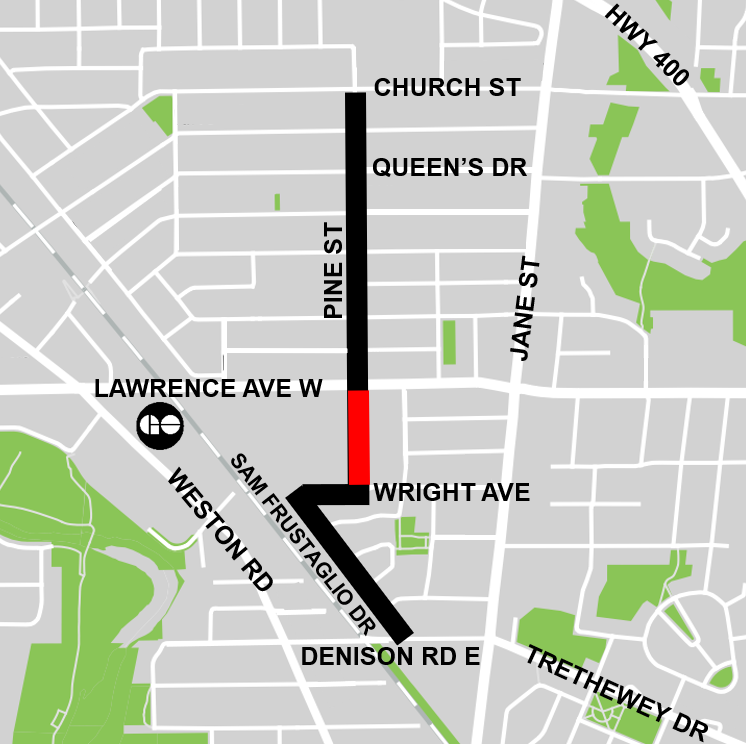

Map of Weston Cycling Connections project area, highlighting proposed Phase 1 cycling facilities along Pine Street from Wright Avenue to Lawrence Avenue West

On Pine Street from Wright Avenue to Lawrence Avenue West, motor vehicle volumes are relatively low and a TTC bus loop utilizes the northbound lane for the 32C Eglinton West route and the 79 Scarlett Road route. There are also several driveway entrances serving the businesses on the west side of the street.

Approved changes:

  • Southbound protected bike lane with flexible bollards and precast concrete curbs
  • Northbound shared lane markings
  • In-road flexible speed signage
  • Bicycle crossing signals at Lawrence Avenue West
  • No changes to parking

Cross-section of Option 1

Map of Weston Cycling Connections project area, highlighting proposed Phase 1 cycling facilities along Wright Avenue and Sam Frustaglio Drive

On Sam Frustaglio Drive and the short section of Wright Avenue connecting to Pine Street, motor vehicle volumes are low enough to warrant using shared lane markings to designate the route.

Approved changes:

  • Shared lanes in both directions
  • No changes to parking

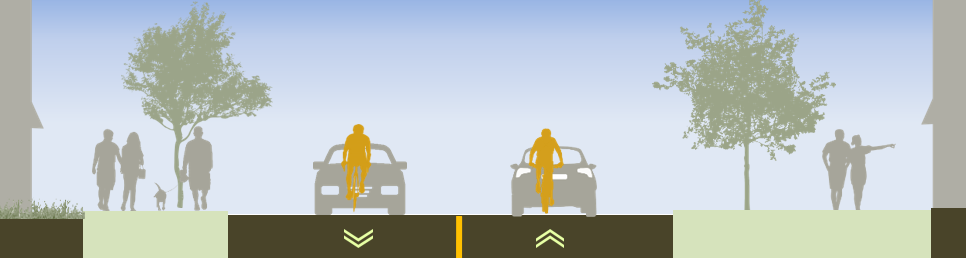

Cross-section of proposed facilities

Phase 2 connection to Trethewey Drive via Denison Road East

In Phase 2 of this project, the existing connection from the cul-de-sac of Sam Frustaglio Drive to Denison Road East, pictured below, is proposed to be upgraded and connected to a new proposed bikeway on Trethewey Drive. Public consultation for this connection and for Trethewey Drive will take place separately in 2024.

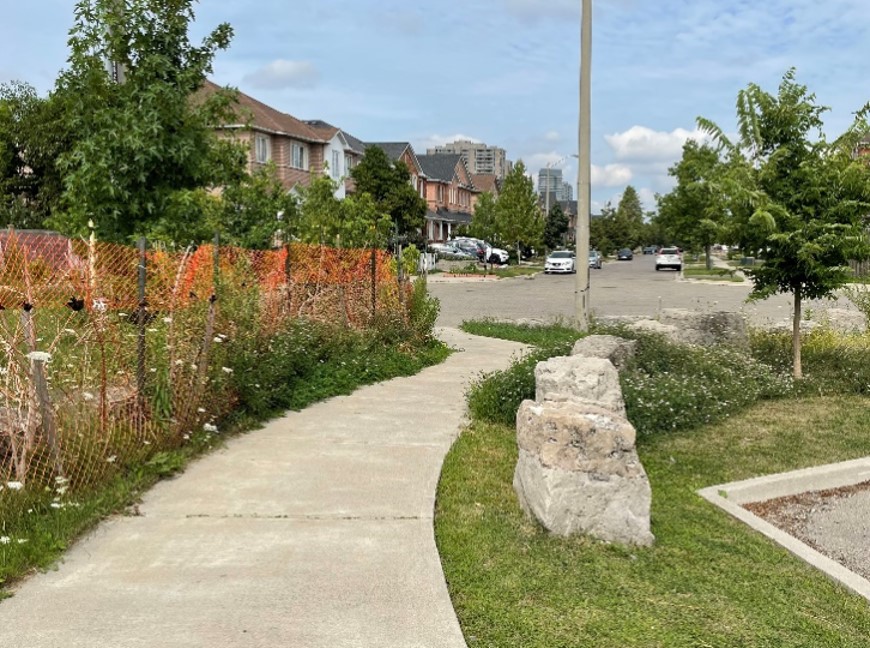

Photo of existing pathway from cul-de-sac of Sam Frustaglio Drive to Denison Road East

Public opinion, along with technical and policy considerations, will be used to inform staff recommendations and decisions made by City Council.

Public consultation and installation for Weston Cycling Connections will take place over three phases, and phase 2 consultation is expected to take place in fall 2024. More information including information on public events and opportunities to provide feedback will be listed here and sent to the project email list in advance.

Phase 1 public consultation took place in fall 2023. The public consultation report (linked below) provides a detailed summary of all activities that took place, proposed changes, and feedback received.

A public drop-in event was held on November 28, 2023. It included a presentation and question & answer period, as well as opportunity to speak with project staff and view display panels. View the display panels and consultation report below.

Consultation Materials

The City Council-approved Cycling Network Plan is a comprehensive roadmap and work plan that outlines the City’s planned investment in our cycling network. It includes a Long-Term Cycling Network Vision, the planned Major City-Wide Cycling Network Routes, and a three-year rolling Near-Term Implementation Program.

The aim of the Cycling Network Plan is to connect gaps in Toronto’s current cycling network by growing existing and future cycling opportunities with safer and more comfortable cycling route options where quality can be improved.

The 2022-24 Near-Term Implementation Program identifies several key cycling routes throughout the Weston neighbourhood to connect key destinations and neighbouring community links.

On March 27, 2024, the Infrastructure and Environment Committee of City Council approved the staff-recommended design for Phase 1 of Weston Cycling Connections with one amendment to preserve on-street parking between Church Street and King Street.

On April 18, 2024, Toronto City Council approved the amended design.

More details are available at IE12.4 and in the Approved Changes accordion tabs above.
