The section of the Gardiner Expressway between Jarvis Street and Cherry Street is nearing the end of its service life and is the number one priority for rehabilitation in the Gardiner Expressway Strategic Rehabilitation Plan.

The City of Toronto is renewing this section of the expressway in a way that’s faster and less disruptive than ever done before.

This work is using an innovative construction method called Accelerated Bridge Construction, which can reduce the construction time by approximately 40 per cent and minimize the impact on the travelling public as well as reduce noise and dust impacts.

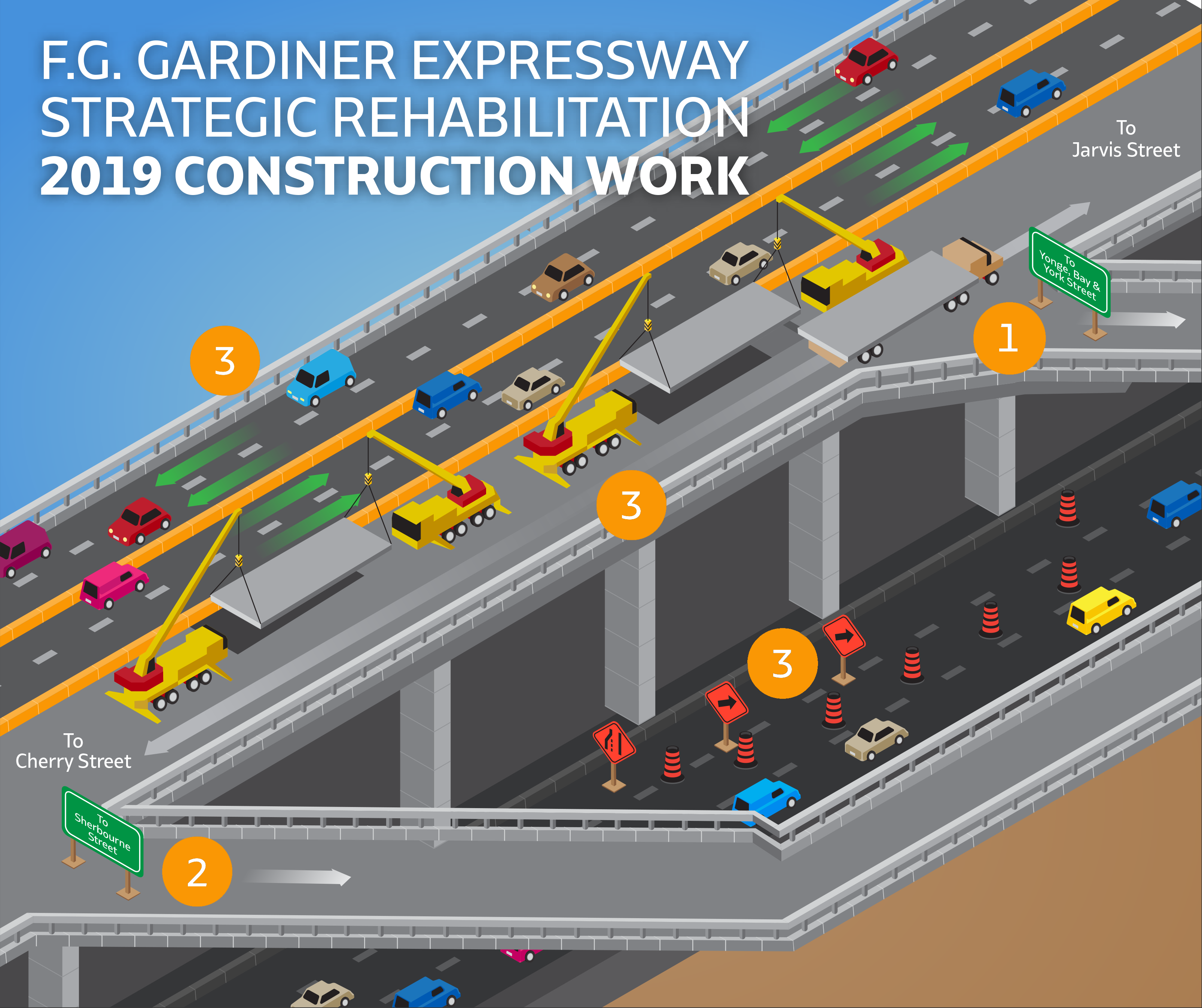

Image depicting the 2019 construction work that will take place on the Gardiner Expressway between Jarvis Street and Cherry Street. Graphic indicates the work phase order. A large Number 1 stands by a sign of westbound Yonge, Bay, York Street off-ramp which will be rehabilitated first in summer 2019. The Number 2 on the graphic indicates the second phase of work, the westbound Sherbourne off-ramp will be closed for replacement. The Number 3 on the graphic demonstrates the third work phase where two lanes of traffic open on the south side of the expressway. On the north side of the expressway, the graphic shows two sets of cranes removing and replacing sections of the expressway deck. Below the expressway on Lake Shore Boulevard, the graphic demonstrates rolling lane closures underneath where sections are being removed with one lane of traffic flowing through.

Work Phase 2019 Construction Activity Details Timeline
1 Yonge-Bay-York Streets Westbound Off-Ramp Rehabilitation
  • Yonge-Bay-York westbound off-ramp will be fully closed for extensive repairs (known as rehabilitation)
  • Consider other westbound off-ramps such as Lower Sherbourne Street or Spadina Avenue
  • To access downtown, consider alternate routes such as exit the DVP onto Richmond Street, exit the Gardiner at Jarvis Street and enter from the east, exit the Gardiner at Spadina Avenue or travel on Lake Shore Boulevard westbound to access Yonge, Bay or York Streets

See below accordion for full details.

Complete 10 p.m. on July 15 to September 22, 2019
2 Lower Sherbourne / Lower Jarvis Streets Westbound Off-Ramp Replacement
  • Lower Sherbourne / Lower Jarvis Street westbound off-ramp will be fully closed for replacement
  • During construction, only one ramp will be closed at a time and this work will begin after the Yonge-Bay-York westbound off-ramp is complete
  • Consider alternate off-ramps such as Yonge-Bay-York or Spadina Avenue, or take the Don Valley Parkway southbound to the Richmond Street East exit
11:59 p.m. on October 4 to April 18, 2020
3 Gardiner Expressway Deck Replacement – North Side between Jarvis Street & Cherry Street
  • The north side of the Gardiner Expressway between Jarvis Street and Cherry Street will be fully closed for full replacement of the concrete deck and steel girders
  • Two lanes of eastbound and westbound traffic will remain open on the south side of the expressway
    There will be closures on the westbound lanes of Lake Shore
  • Boulevard East during off-peak hours (between 10 a.m. to 3 p.m., Monday to Friday, and 10 p.m. to 5 a.m. Sunday to Thursday) and there may be instances in the off-peak hours where traffic will be paused for 15 minutes so crews can safely remove and replace sections of the expressway above
  • The City is allowing for longer Lake Shore Boulevard East lane closures to help accelerate construction for the rehabilitation work to the Gardiner Expressway between Cherry Street and Lower Jarvis Street. Lake Shore Blvd E westbound lanes will be reduced to one lane from 9 a.m. to 4 p.m., Monday to Friday, from 8 p.m. to 6 a.m., Sunday to Thursday, and from 7 p.m. to 7 a.m. Friday to Sunday.
  • This phase is using an innovative technique called Accelerated Bridge Construction which can reduce construction time by up to 40 per cent

This technique removes sections of the existing expressway deck and replaces it with custom built pre-fabricated sections.

5 a.m. on October 14 to July 27, 2020



Work Phase 2020 Construction Activity Details Timeline
4 Ramp Replacement – Eastbound On-Ramp at Jarvis Street
  • The eastbound on-ramp at Jarvis Street will be fully closed for replacement
May 18, 2020 to Spring 2021
5 Gardiner Expressway Deck Replacement – South Side between Jarvis Street & Cherry Street
  • The south side of the Gardiner Expressway between Jarvis Street and Cherry Street will be fully closed for full replacement of the concrete deck and steel girders
  • This work will take place at the same time as the replacement of the eastbound on-ramp at Jarvis Street
  • Two lanes of eastbound and westbound traffic will remain open on the north side of the expressway
  • Due to the current COVID-19 pandemic, the City is allowing for longer Lake Shore Boulevard East lane closures to help accelerate construction. Lake Shore Boulevard East will be reduced to one lane in each direction between Parliament and Jarvis Streets: Monday to Friday from 9 a.m. to 4 p.m., Friday to Sunday from 7 p.m. to 7 a.m. and Sunday to Thursday from 8 p.m. to 6 a.m. There also may be instances in the off-peak hours where traffic will be paused for 15 minutes so crews can safely remove and replace sections of the expressway above
  • The deck and ramp replacement is using an innovative technique called Accelerated Bridge Construction which can reduce construction time by up to 40 per cent
  • This technique removes sections of the existing expressway deck or ramp and replaces it with custom built pre-fabricated sections.
July 27, 2020 to Spring 2021

About Accelerated Bridge Construction

This project is using an accelerated bridge construction method that can reduce the construction time by as much as 40 per cent compared to traditional methods. This will be the first time this method has ever been used in Toronto and at this scale in an urban centre.

This method involves building sections (i.e. panels) of the new expressway off-site in a climate controlled facility, or fabrication site, and then transferring the sections into place on the Expressway where existing sections have been removed.

Faster, Less Disruptive & Higher Quality Construction

Using this accelerated method, this project – which spans a 1.5km work zone – will be completed in less than two years. In comparison, the work on the Gardiner West deck rehabilitation from Bathurst Street to Strachan Avenue used traditional methods and took two and a half years to complete with a work zone half the size.

Unlike traditional methods, accelerated bridge construction does not require regular jack-hammering and therefore reduces the impact of noise and dust. As well, since the components are made in a quality and climate controlled facility, the final construction product is typically of a better quality.

Fabrication Site

You may have noticed heavy machinery, site trailers and large tent structures on lands by Lakeshore Blvd East near Cherry Street. This is the City’s fabrication site and staging area for the Gardiner Expressway Strategic Rehabilitation from Jarvis to Cherry Street.

The large tent structures is the fabrication site where crews will build nearly 400 panels that will replace the expressway deck between Jarvis to Cherry Streets and the westbound off-ramp at Sherbourne Street and the eastbound on-ramp at Jarvis Street. Each panel is unique to the design of the expressway and ramps.

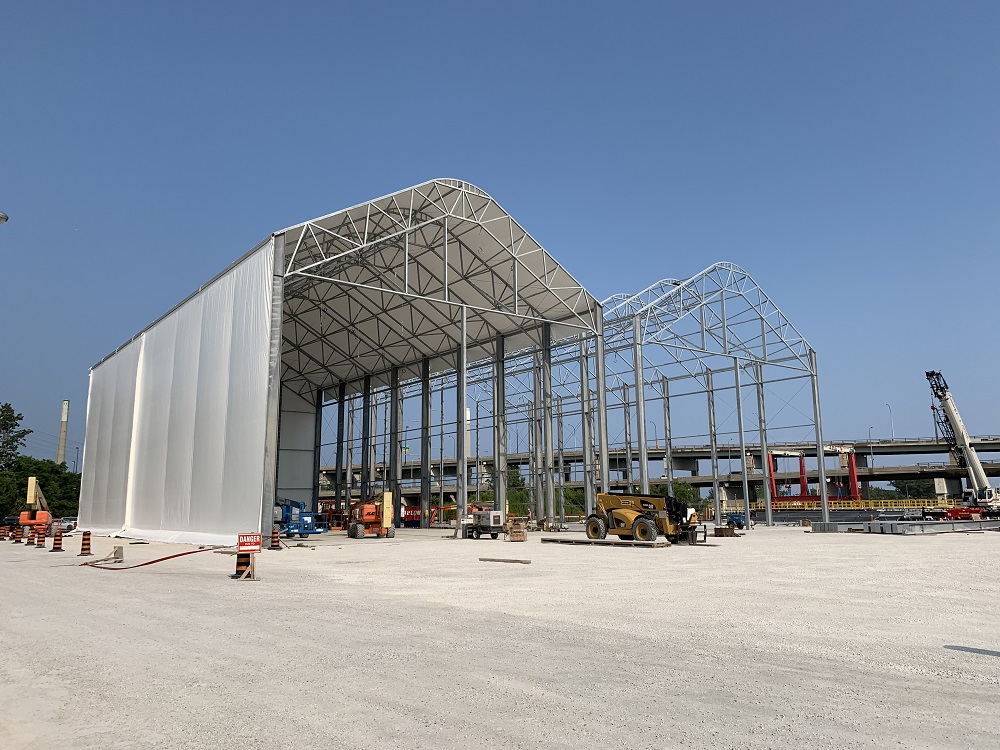

Image of Gardiner Expressway Strategic Rehabilitation, Jarvis to Cherry fabrication site located on lands near Lakeshore Blvd E and Cherry St. Image features two large tent structures, one with a canvas cover and the other just a metal frame with the Gardiner Expressway in the background.
Fabrication site under construction, these facilities are where the expressway and ramp replacement panels will be build. Click to enlarge.

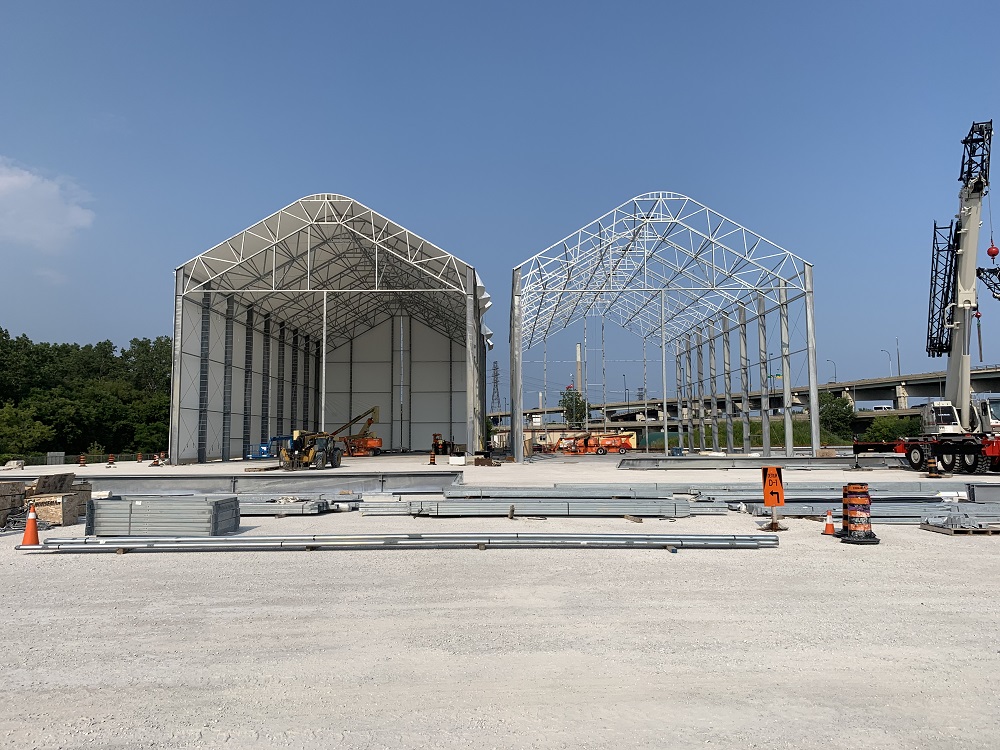

Image of Gardiner Expressway Strategic Rehabilitation, Jarvis to Cherry fabrication site located on lands near Lakeshore Blvd E and Cherry St. Image features two large tent structures in the process of assembly straight on view, one with a canvas cover and the other just a metal frame with the Gardiner Expressway in the background.
Click to enlarge.

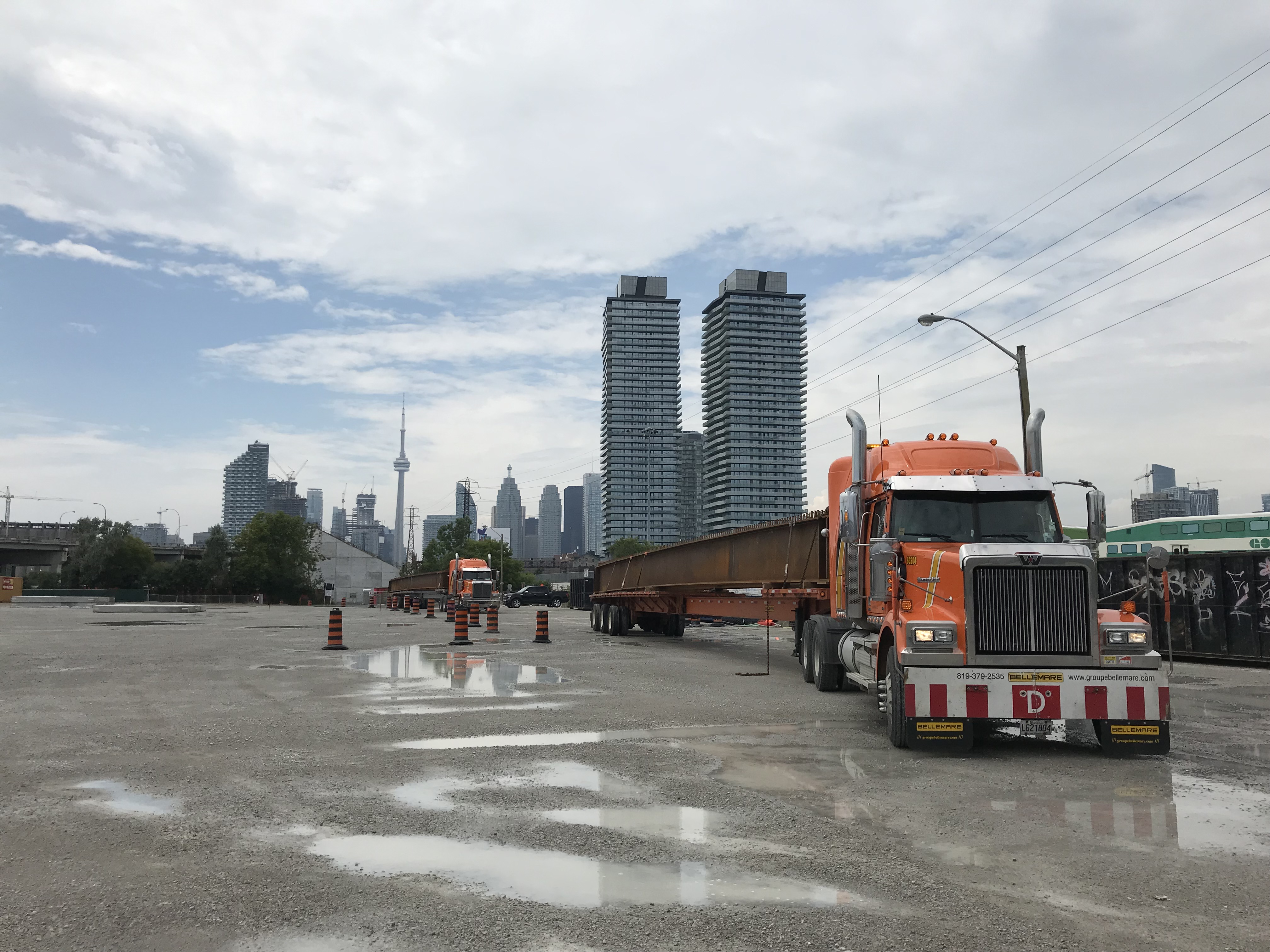

Image of trucks pulling up on the fabrication site with a steel girder
Steel girders which will be used to create the new expressway panels arrive at the fabrication site

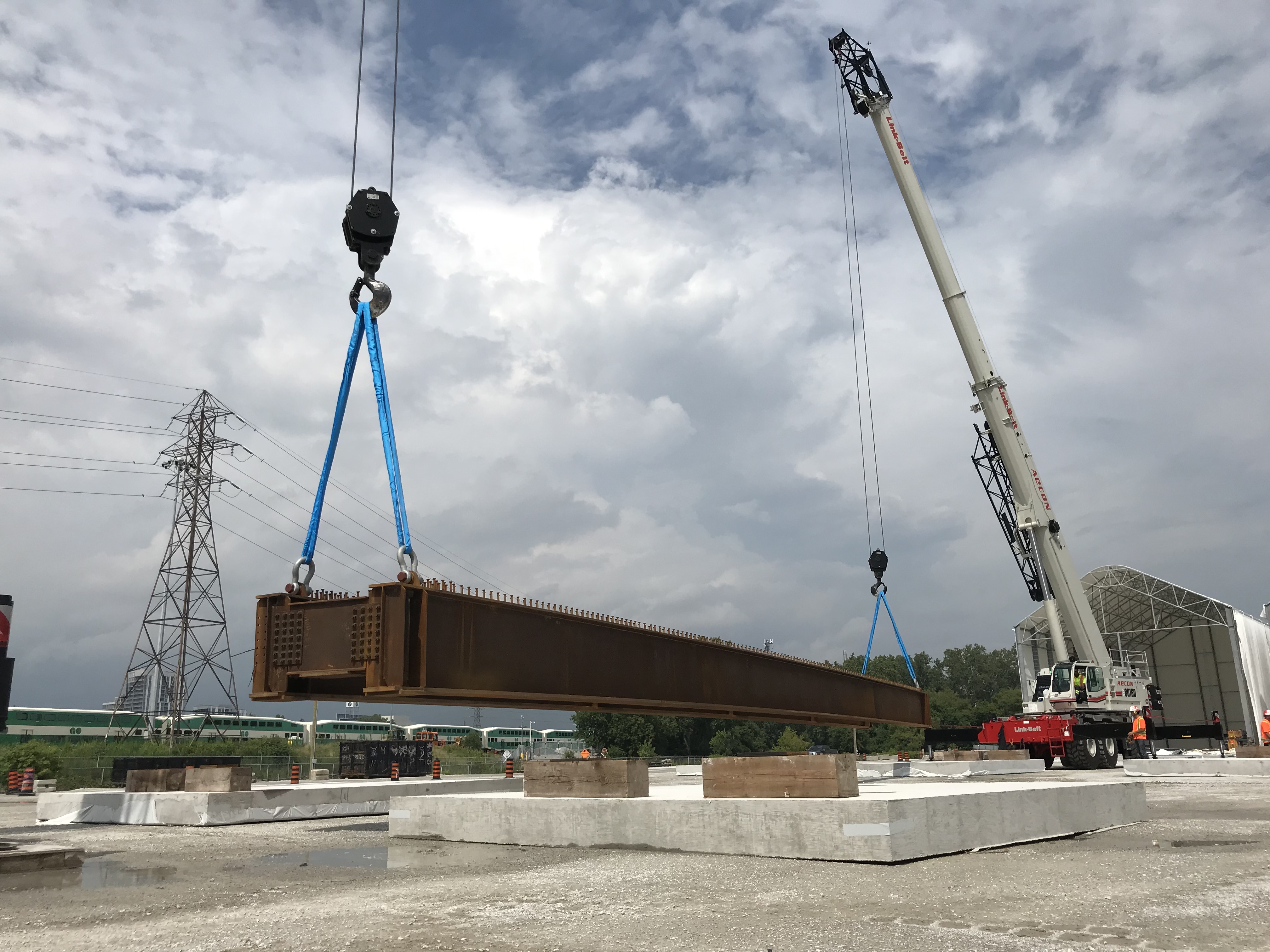

Image of cranes lowering the steel girder onto a concrete platform
Cranes lift the steel girder from the truck onto a concrete platform
