The next phase of this project will involve the development of detailed designs and continued public consultation.
Originally a 1.4 km gap in the Humber River Trail (HRT) near Weston Road and Lawrence Avenue West, approximately 800 metres of trail remains to be completed. This gap constitutes a significant barrier to a continuous multi-use trail system both along the HRT and in the future Loop Trail. The Loop trail is a 65 km off-road, multi-use ring that will connect multiple ravines, neighbourhoods and trail systems throughout Toronto. Existing routes present safety concerns to users who are forced to detour along busy local roads that lack designated cycling infrastructure and are not fully accessible.
The study is being conducted in partnership by Toronto and Region Conservation Authority (TRCA) and City of Toronto.

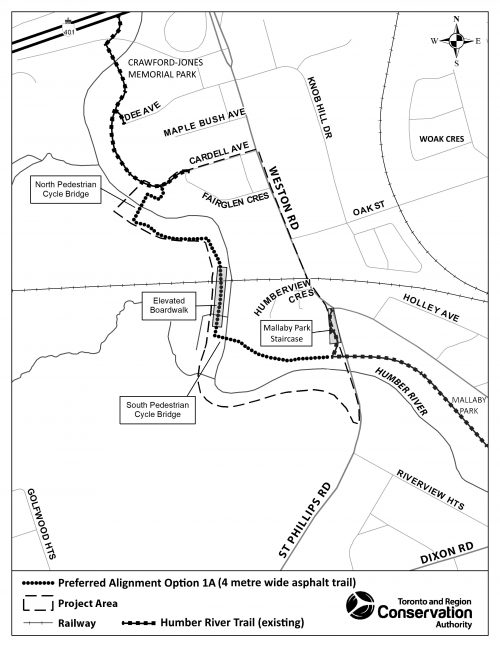

The Preferred Trail Alignment, as documented in the final report, includes an in-valley alignment, paved multi-use trail, including two pedestrian-cycle bridges with an elevated boardwalk. The next steps include the final phase of planning, detailed design and continued engagement with local stakeholders.
During detailed design, the in-valley preferred trail alignment will undergo a higher degree of refinement and will include:
The project team is at the early stages of the detailed design and will inform local property owners and community once the schedule for engagement activities is determined. The estimated design timeline could be 2024-2026+ with implementation 2026 -2028+ which is subject to change depending on approvals required.
On December 8, 2023, the Minister of the Environment, Conservation and Parks (MECP), Andrea Khanjin, provided the City approval to advance the project with the requirement of two additional studies during detailed design that must be provided to the Ministry prior to commencing construction – a safety plan that satisfies the requirements of emergency services, and a flood and ice jam mitigation plan.
On January 18, 2023, the Ontario Minister of Environment, Conservation, and Parks issued an order requiring that the City of Toronto and Toronto Regional Conservation Authority carry out an individual environmental assessment for additional study.
City staff reported to City Council on March 8, 2023, about the status of the Mid-Humber Gap project, seeking authority for the City to apply to the Court for judicial review of the matter. The report can be found here: Legal Advice in response to Provincial Order Requiring Individual Environmental Assessment for new Multi-Use Trail.
As such, the City commenced a Notice of Application for Judicial Review in Divisional Court challenging the Province’s order for further study on the Mid-Humber Gap Trail however the Minister agreed to a consent order from the Court setting aside the order issued on January 18, 2023.
The project was then remitted back to the Minister for reconsideration and a decision within 30 days of the November 8, 2023, Divisional Court Order.
The final report was placed on public record for a 30-day review period from October 20 to November 19, 2022 and is available for review on this web page under the Final Report tab.
On July 7, 2022, the Infrastructure & Environment Committee (IEC) endorsed IE31.11 – staff recommendations for the preferred trail alignment, an in-valley option.
On July 19, 2022, City Council adopted the preferred in-valley trail alignment that will close the existing gap in the Humber River Trail network and authorized the City to file the Mid Humber Gap Environmental Assessment (EA) Notice of Completion and post the study report for a 30-day review period. A copy of the staff report is available under IEC agenda item IE31.11.

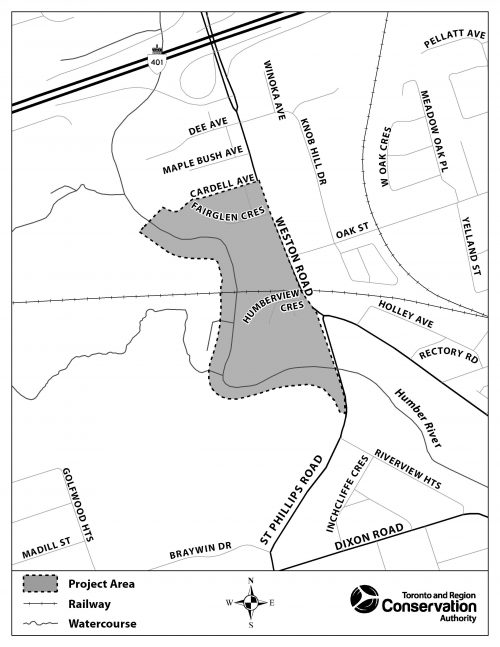

The Mid Humber Gap project area is located between two completed sections of the Humber River Trail (HRT) just south of Mallaby Park and west of St. Phillips Road and the southern entrance to Crawford-Jones Memorial Park off Cardell Avenue.
Consultation for the Mid Humber Gap Trail has engaged a broad range of residents, businesses, and stakeholders over two rounds of engagement.
A Stakeholder Advisory Group (SAG) comprised of stakeholder representatives and local residents was formed to review and provide feedback throughout the Environment Assessment process. The SAG assists in building a consensus on the Mid Humber Gap’s primary objective – to identify a preferred multi-use trail alignment for the remaining approximately 800 metre gap in the Humber River Trail (HRT).
The City and TRCA presented to the SAG on Wednesday, May 5, 2021, on the SAG Terms of Reference, project background, Municipal Class Environmental Assessment process, planning context, preliminary screen matrix, and project timeline and again, on Thursday, February 3, 2022, on the Preliminary Preferred Trail Alignments, Evaluation Matrix and Design Considerations for Preferred Alignment.
Meeting Minutes are available in the Consultation Reports above.
The Mid Humber Gap Project was one of 26 projects identified in the Bikeway Trails Implementation Plan adopted by Toronto City Council in 2012 and a near-term priority in the 2019 Cycling Network Plan Update.
In 2013, the City and Toronto & Region Conservation Authority (TRCA) completed Stage 1 of the Mid Humber Gap project. During Stage 1, a 600-metre trail was constructed to connect Mallaby Park to the HRT system and a pre-existing dirt trail was formalized into a 3.5 metre-wide paved multi-use pathway.
In 2019, the City and TRCA completed Stage 2 of the Mid Humber Gap project to evaluate conceptual trail alignment options to close the remaining gap of approximately 800 m in the HRT between Mallaby Park and Crawford-Jones Memorial Park.
The Feasibility Study provides a project rationale for pursuing Stage 3 – Municipal Engineer Class EA (MCEA) Schedule B Planning Process. The Feasibility Study evaluated a range of conceptual trail alignments, culminating in a recommended “in-ravine” and “on-road” option.
Trail alignment constraints include steep grades, challenging topography and private property considerations. These constraints increase the complexity of the project and may require construction of bridges, boardwalk structures and negotiations with private landowners. The Feasibility Study also confirmed the need to conduct a more thorough investigation via an MCEA Schedule B process.
The Mid Humber Gap is currently in Stage 3 and subject to MCEA Schedule B requirements.
Building off the work already completed as part of a Feasibility Study, the planning and design of the Mid Humber Gap followed the Schedule B requirements for a Municipal Engineer Class EA (MCEA) process. The MCEA meets the intent of the EA Act by providing for the identification of problems or opportunities; giving due regard to the need to protect the environment and minimize effects; and consulting with affected stakeholders early and throughout the decision making process (Municipal Engineers Association, amended 2015).
The study considered the following items to determine the location and alignment for the new trail connection:
A Final report was available for a 30-day review period from October 20 to November 19, 2022. See Notice of Study Completion.
Executive Summary
Chapter 1 Introduction
Chapter 2 Environmental Assessment Process
Chapter3 Consultation Strategy
Chapter4 Planning Context and Opportunity Statement
Chapter 5 Existing Conditions Part 1
Chapter 5 Existing Conditions Part 2
Chapter 6 Evaluation of Trail Alignment Concepts
Chapter 7 Alternative Design Concepts for Preferred Trail Alignment
Chapter 8 Description of Preferred Trail Alignment Concept
Chapter 9 Environmental Impacts and Mitigation
Chapter 10 Permits and Approvals
Chapter 11 Future Work
Chapter 12 Potential for Future Amendment
Chapter 13 References
Chapter 14 Glossary
For a copy of any of the appendices, please contact us.
