Project Scope

The City of Toronto upgraded the existing bicycle lanes on Birmingham Street between Kipling Avenue and Dwight Avenue to protected bicycle lanes (cycle tracks). The project scope included upgrading the pavement markings to add a painted buffer area between the existing bike lane and the motor vehicle travel lane and installing concrete curbs to provide physical separation between people driving or parking and people cycling.

This project was approved at the City’s Infrastructure & Environment Committee Item IE20.13 on March 23, 2021, and City Council on April 7, 2021.

Pre-Construction Notice

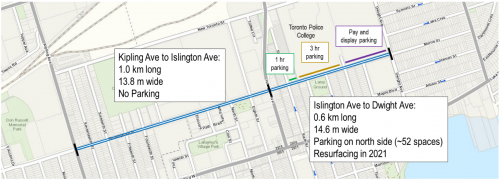

Map of study area

Why Upgrade?

In 2021, the City of Toronto resurfaced Birmingham Street between Islington Avenue and Dwight Avenue as part of the City’s state of good repair program. When a road resurfacing is planned, there is an opportunity for road design modifications to increase safety.

A number of criteria are considered to determine the most appropriate bikeway type for a street to be safe and comfortable for people of all ages and abilities. Based on the motor vehicle volume and speed along the corridor, upgrading the bicycle lanes to cycle tracks is warranted.

Cycle Tracks Explained

Protected bicycle lanes, also called cycle tracks, are lanes for people cycling that are physically separated from motor vehicle traffic. Cycle tracks have been shown to create a safer street for all users including people driving, walking, and cycling.

Some cycle tracks, including the cycle tracks on Birmingham Street, have vehicle parking beside the lane. When passengers and drivers are leaving their vehicle, they must first ensure the cycle track is clear. The buffer area next to the parking lane is designed to provide room for people to enter and exit their vehicle.

Protected bicycle lane on Willowdale Avenue with curbs and bollards

Protected bicycle lane on Willowdale Avenue with curbs and bollards

Road Configuration

Kipling Avenue to Islington Avenue

Previous:

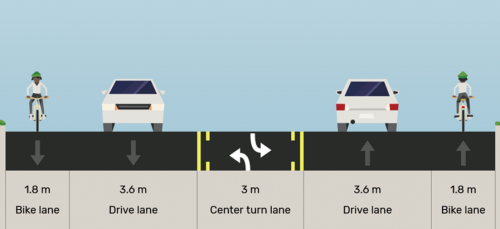

Kipling-Islington Existing: "1.8 m westbound bike lane, 3.6 m westbound travel lane, 3 m centre turn lane, 3.6 m eastbound travel lane, 1.8 m eastbound bike lane"

Upgraded:

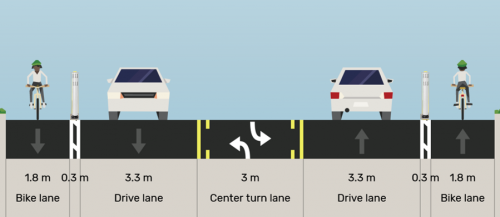

Kipling-Islington Proposed: "1.8 m westbound bike lane, 0.3 m buffer with curbs and bollards, 3.3 m westbound travel lane, 3 m centre turn lane, 3.3 m eastbound travel lane, 0.3 m buffer with curbs and bollards, 1.8 m eastbound bike lane"

Islington Avenue to Dwight Avenue

Previous:

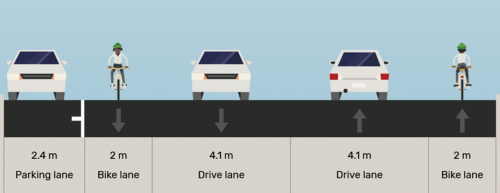

Islington-Dwight Existing: "2.4 m westbound curbside parking lane, 2 m westbound bike lane, 4.1 m westbound travel lane, 4.1 m eastbound travel lane, 2.0 m eastbound bike lane"

Upgraded:

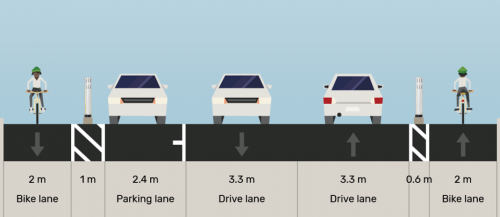

Islington-Dwight Proposed: "2 m westbound curbside bike lane, 1 m buffer with curbs and bollards, 2.4 m westbound parking lane, 3.3 m westbound travel lane, 3.3 m eastbound travel lane, 0.6 m buffer with curbs and bollards, 2.0 m eastbound bike lane"

What Does This Project Mean for You?

If you drive or park on Birmingham Street:

All existing motor vehicle lanes were maintained, but narrowed to encourage greater compliance with the existing speed limit. The existing parking along the north side between Islington Avenue and Dwight Avenue was shifted away from the curb. Approximately five parking spaces were removed to improve sightlines at driveways. Accessible parking or pick-up / drop-off that cannot occur off-street was accommodated within the parking lane or on side streets.

If you cycle:

Painted buffers, concrete curbs, and bollards were added to separate the cycle tracks from the motor vehicle lanes. The existing westbound bicycle lane between Islington Avenue and Dwight Avenue was relocated against the north curb, between the parking lane and sidewalk.

If you walk:

The concrete curbs proposed to separate the cycle tracks increase separation between motor vehicle lanes and sidewalks. The road resurfacing between Islington Avenue and Dwight Avenue included sidewalk upgrades that reduce crossing distances and encourage slower turning speeds.

If you live in the neighbourhood:

City services such as fire, emergency medical services, and solid waste pick-up were maintained. Separate snow clearing occurs for sidewalks, cycle tracks, and roadway.

Residents were invited to provide feedback and questions by phone or email by February 19, 2021.
