Road maintenance is essential in keeping the F.G. Gardiner Expressway in a state of good repair. The roadway is a key element of Toronto’s transportation system and allows people and goods to travel in and out of the city every day, stimulating economic growth and development.

The City performs regular spring or fall maintenance every couple years on the Gardiner Expressway. This maintenance typically involves a full or partial closure of the expressway over a weekend that allows City road crews, engineers and other stakeholders to make improvements and keep the through-way in a state of good repair.

A full closure of the F.G. Gardiner Expressway, from the Don Valley Parkway/Carlaw Avenue to Highway 427/Queen Elizabeth Way took place on Friday, May 29 at 11 p.m. to Monday, June 1 at 5 a.m.

Work completed during the closure:

  • 172.6 tonnes (137 loads) of sweeping debris removed
  • 11.2 tonnes of garbage/litter removed
  • 49,663 square metres of asphalt milling and concrete pad removal completed
  • 7,516.3 tonnes of asphalt used for resurfacing three sections of the expressway
  • 155.6 tonnes of asphalt used for surface repairs
  • 6,792 metres of new pavement markings installed
  • 77.3 metres of concrete gutter replaced
  • 366.2 metres of temporary concrete barrier installed
  • 6 CRASH system removed and replaced or repaired
  • 27 coring samples taken
  • 490.2 metres of guiderail repaired
  • 1 ramp gate repaired
  • 1 expansion joint repaired
  • 11 catch basins rebuilt or adjusted
  • 1024 catch basins cleaned
  • 303 square metres of graffiti removed
  • 23 tonnes of wood chipping completed
  • 4 RESCU traffic counting loops replaced
  • 125 vehicle detection stations tested (1 repaired)
  • 8 RESCU cabinets maintained
  • 7 traffic cameras repaired or upgraded
  • 1 overhead digital message sign repaired
  • 1 RWIS Weather Station repaired
  • 268 signs inspected
  • 2,000 metres of durable markings installed
  • 203 expressway lights maintained and repaired
  • 25 base-mounted expressway poles replaced or removed
  • 2 high-mast expressway poles removed
  • 50 bridge expansion joints cleaned
  • 13 bridges chipped

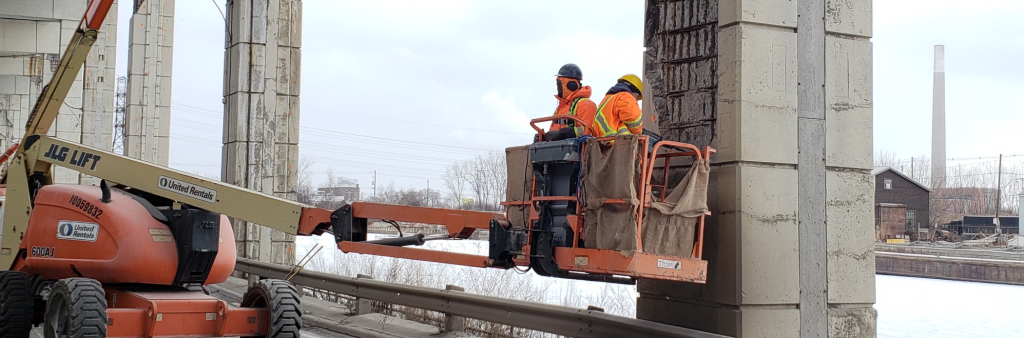

  • Inspection of elevated portion of the expressway as well as structures crossing the expressway

View the 2018 Gardiner Maintenance Video.

The Gardiner Expressway has been in service for over 60 years. There is the potential for pieces of concrete from the underside of the structure to become loose. However, while these incidents are serious, it must be noted that they are in no way an indication that the expressway is not structurally sound.

After several concrete falls were recorded from the Gardiner Expressway in 2012, the City enhanced its inspection and controlled chipping program. The table below summarizes the calls received by the City every year since 2012 alerting of incidents of fallen concrete:

Year Calls Received Total
2018* 2 confirmed
7 unconfirmed
9
2017 0 confirmed
4 unconfirmed
4
2016 3 confirmed
9 unconfirmed
12
2015 6 confirmed
14 unconfirmed
20
2014 4 confirmed
15 unconfirmed
19
2013 5 confirmed
19 unconfirmed
24
2012 4 confirmed
5 unconfirmed
9

* As of December 6, 2018

Standardized visual inspections of the Gardiner Expressway are conducted every two years, in accordance with Provincial guidelines. The inspections assess the condition of the various components of the expressway.

In addition, up-close detailed inspections of the expressway are conducted twice per year, including the underside of the elevated portion and fascia (a concrete cover).

These inspections guide the City’s controlled chipping program where crews use equipment to remove potentially loose pieces of concrete cover from the sides or underside of the structure.
