All community updates will be saved in this list. Click on each date to read the full text.

Update #17, March 7, 2019.

A new design for David A Balfour Park!

Join us at a public meeting to learn about enhancements to David A Balfour Park!

  • Date: Tuesday March 26, 2019.
  • Time: Doors Open 6:30 p.m.
  • Presentation: 7 p.m.
  • Location: Christ Church Deer Park, Elliot Room
  • Address: 1570 Yonge Street

If you cannot attend, the presentation and display materials will be posted on the webpage the day after the meeting.

The park plan includes:

  • A redesign of the park entrance and water feature
  • Pathways and lighting
  • Public bathroom
  • Park amenities, such as seating, benches, picnic tables, trellis.
  • Tree canopy

Send us your comments and questions by Friday April 5, 2019 and contact us with accessibility requests 416-392-1932.

Update #16, January 17, 2019.

Revised Construction Schedule Phase 2A and 2B

Previous issues regarding the temporary boardwalk and poor/wet weather days in 2018 has held back the construction schedule. To recoup this time, the City’s contractor will be:

  • Carrying out work on Saturdays starting January 26 until the end of 2019
  • Advancing the start date for work on the eastern perimeter area, below the reservoir’s slope, which was originally scheduled for Phase 2 this Summer.

The construction schedule is revised:

  • Phase 2 will be divided into two parts: Phase 2A and Phase 2B
  • Phase 2A will start February 4 to July 31 and include the area at the eastern perimeter below the reservoir’s slope
  • Phase 2B keeps with the original construction schedule, which will begin August to December 2019 and result in a full park closure

The blue area from the playground towards the Summerhill Entrance will be temporary closed for 3 weeks to carry out tree protection and removals. Notice will be provided if this closure affects access to the Garden.

Correction to Construction Notice #5

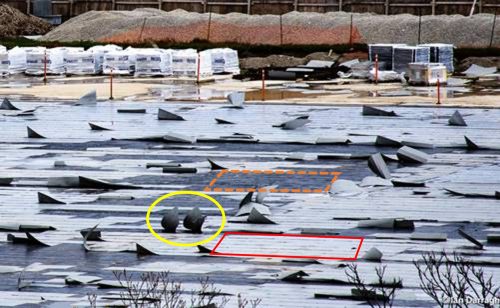

The Construction Notice has clarified a detail on Page 2, second row, first column and indicates Phase 2A from February 4, 2019 to July 31, 2019.

Aerial map of Rosehill Reservoir and David A Balfour Park showing the areas closed for Phase 1 and 2A, as well as a portion near the playground for a temporary three week closure. Access to the Garden via Summerhill Avenue will be open in Phase 2A until late July. Phase 2B starts in August to December, 2019 and results in a full park closure.

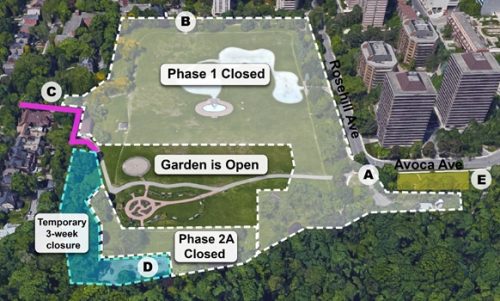

Rosehill Reservoir Phase 2A map
Legend
  • White area indicates Phase 1 and 2A closure
  • Blue area indicates a temporary three week closure late February
  • Pink line indicates access to garden via Summerhill Entrance
  • A is the main access point
  • B is Jackes entrance
  • C is Summerhill Entrance/Little Park
  • D is the playground
  • E is the Avoca Avenue Plant Beds

Washroom Hoarding and Demolition

The contractor will begin work to demolish the washroom starting December 7. Hoarding will be adjusted to enclose the building. Please see information in the attached Notice. Due to delays in Canada Post delivery, this notice will not be mailed out to the community.

Idling Update

We have repeatedly asked the contractor to stop truck idling on neighbourhood streets (especially Pleasant Boulevard). If you do see idling trucks, please contact rosehill@toronto.ca, 311@toronto.ca and pparking@toronto.ca with the following information:

  • License Plate number
  • Location of the truck
  • Approximately how long the truck was idling
  • Time of date (to establish a pattern)

Memorial Tree Impacts

Over the next two weeks, three (3) memorial trees located within Phase 1 work area will be impacted. Two (2) trees will be transplanted to a new location and one tree will be removed and replanted before the end of construction. Transplanting and removing these trees are required to carry out work in Phase 1.

Staff have had direct contact with the family of one tree and have sent emails and a letter to the families of the remaining two trees since the phone numbers of those families are no longer in service.

Work on Saturdays to facilitate Phase 1 Construction

The Contractor will be starting work on Saturdays starting November 3 to December 22, 2018 from 9 a.m. to 5 p.m. to continue to remove soil, remove the existing waterproofing membrane and install the new one. Please see this notice.

  1. Tree Root Exploration
  2. Injured Tree Removal
  3. On-Street Parking Restrictions on Summerhill Avenue
  4. Temporary Garbage Bin on Rosehill Avenue
  5. Idling on Pleasant Boulevard

Tree Root Exploration

Please see the notice. The contractor will be carrying out tree root exploration on trees located near the lower perimeter pathway from Little Park to south of the construction hoarding at Avoca. The purpose is to determine the condition of trees for Phase 2 construction work and park design planning before the winter season freezes the ground. The work will be noisy and segmented within a temporary fence. Work hours are 7 a.m. to 5 p.m., Monday to Friday and will start October 25 to December 23, 2018.

Injured Tree Removal

A tree by the north-east corner of the Valve House will be removed within the next two weeks (weather permitting) as our colleagues in the Parks division have determined that a split down the trunk (stem) is a significant impact to the tree’s health and condition. See photo below. The project manager has agreed to carry out this removal on behalf of Parks through the Rosehill Reservoir Rehabilitation contractor.

Tree by Valve House is split and requires removal
Tree by Valve House is split and requires removal

On-Street Parking Restrictions on Summerhill Avenue

If you are a resident on Summerhill Avenue, Ottawa Street, Summerhill Gardens or park on-street on Summerhill Avenue near Little Park, please see the message below about on-street parking restrictions.

Please see the Notice that will be delivered to homes and the Flyer that will be placed on car windshields parked on Summerhill Avenue.

From Monday October 29 to Friday December 21, from 7 a.m. to 5 p.m., weekdays only, a 40 metre portion on the south-side, curb lane on Summerhill Avenue, near Little Park/Summerhill entrance will be restricted to ensure sufficient space for large vehicles to turn from Summerhill Avenue through Little Park.

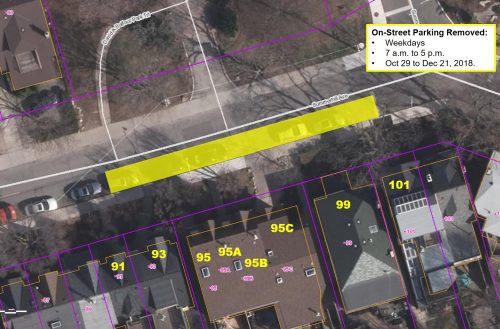

Rosehill Reservoir: A map of Summerhill Avenue on-street parking restrictions during the daytime from 91 Summerhill Avenue to 101 Summerhill Avenue to allow large trucks to turn into the park to the Valve House
Rosehill Reservoir: Summerhill Avenue on-street parking restrictions

These special deliveries of large equipment and supplies are required to carry out work at the Valve House Parking Lot. This work is required to be completed within Phase 1 while the West Basin of the reservoir is empty. The contractor is using the smallest vehicle to provide these supplies as close as possible to the Valve House, and is not expecting to damage the grass in Little Park.

Unfortunately, this road restriction includes the following temporary impacts to on-street parking:

  • On-Street Parking Spaces: Approximately 6 – 8 on-street parking spaces will be impacted. A flyer will be placed on the windshields of parked cars on Summerhill and notice will be sent to homes. Overnight on-street permit parking will continue; we are asking permit holders to move their vehicle by 7 a.m. if they have parked their car in front of 91 to 101 Summerhill Avenue.
  • New Temporary Permit Restrictions: We have also requested that the Permit Office not issue temporary permits in this area during this time as this area is already near capacity for permanent permit holders.
  • Vehicle is Relocated: As the hours of delivery are 7 a.m. to 5 p.m. we greatly appreciate your cooperation to move your car from these spaces. If cars are not moved, the contractor will knock on the doors of surrounding homes to find the vehicle owner. If they cannot find the vehicle owner, the contractor will request enforcement staff (Toronto Police) to relocate the vehicle to the nearest available on-street parking space.
  • If you vehicle is relocated: Please contact Enforcement 416-808-2222
  • Parking Tickets: If you receive a parking ticket, you can quote “Rosehill Reservoir” as part of your defence for parking consideration during construction; however, the Reservoir Rehabilitation Project Manager does not have the authority to cancel any tickets.

Example of Construction signage Toronto Police which states no parking on this side of the street
Construction Signage Toronto Police

Example of the signage that will be posted in this area. (Please Note: This is standard Toronto Police signage for construction, it is not related to an emergency)

Temporary Garbage Bin

There has been a few complaints about litter near the Rosehill Avenue walkway to Pleasant Boulevard (between 50 and 70 Rosehill). Our colleagues in Solid Waste have placed a temporary bin on the south side of Rosehill near Bretton Place (33 Rosehill). We have asked the property managers to circulate this with their residents and asking that neighbours use these bins to keep the area clean.

Idling on Pleasant Boulevard

I’ve received a number of complaints about trucks idling on Pleasant Boulevard. These trucks are not related to the Rosehill Reservoir work; they are likely part of the Bell Canada work to install new cables. Please contact Bell Canada at 416-353-3827, quote Project #BGF-X79766 or email toinview@bell.ca

The Important Information tab has been updated as we have received many questions about the pathways.

Mon August 27: New Access Points & Trucking on Rosehill Avenue

Two new access points for trucking activities will be located along Rosehill Avenue. This is required to expedite the Phase 1 construction schedule after staff efforts were re-directed to review safety concerns of the temporary boardwalk at north-east corner and carry out tree root explorations (see Update #8).

This temporary change:

  • Will start Monday August 27 (construction of the access points)
  • Will continue for Phase 1 and 2. See note below.
  • Will facilitate an additional 3 trucks per hour. See note below.
  • Will not result in trucks queuing on Rosehill Avenue and will not impact trees
  • Will have 2 gates installed in the jersey barrier for the temporary sidewalk and hoarding for truck entry and exit
  • Will have a flag person to coordinate safe entry/exit of trucks with pedestrians on the temporary sidewalk (jersey barriers)

As a result of these new access points at Rosehill Avenue,

  • Maximum number of trucks at the new Rosehill Access Points is 3 per hour
  • Maximum number of trucks at Avoca Main Access Point is 3 per hour
  • A combined maximum number of trucks for this project is 6 per hour.

These two new gates during Phase 1 will facilitate the removal of existing soil, and the construction of a valve chamber infrastructure. Phase 2 includes ongoing work on the valve chamber and bringing in new soil. Each soil handling stage requires 6-8 weeks.

City staff have supported this change to address the schedule impacts that resulted from the above-mentioned issues. This change was also presented to the Councillors’ office and representatives of neighbourhood associations. We apologize that this is another change from the original plan for construction work.

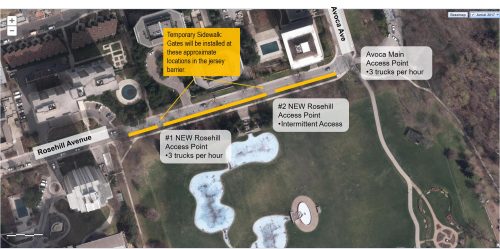

Two additional access points on Rosehill Avenue to provide more trucks to make deliveries and load soil onto trucks for removal off site
Trucking Rosehill Access Points

Portable Washrooms

Based on overwhelming response, portable washrooms will not be installed at Little Park, near the Summerhill entrance for Phase 1.

On Update #7 August 10, the City provided advance notice and rationale for providing the portable washrooms: “The washroom building will also be closed. Maintenance vehicles will not be able to access the washroom to perform the required maintenance. Portable washrooms will be located at the Summerhill entrance to the Park.”

Noise at Valve House on Monday August 27, 2018.

Crews will be performing Hydrovac activities at the Valve House parking lot on Monday August 27, 2018. It will be for the full day and will be noisy. Apologies in advance.

The following construction activities for the Rosehill Reservoir will start next week:

  1. tree removals
  2. soil removal
  3. washrooms in Little Park

Tree Update

Earlier this Spring, trees at the top of the reservoir slopes as well as trees that would have been severely damaged (i.e. could not be preserved) as a result of the rehabilitation work during Phase 1, were removed by the Contractor.

For trees that could potentially be impacted, the Contractor was required to carry out root exploration before determining the next steps. Root exploration efforts for Phase 1 has now been completed and will result in the following actions:

  • One (1) tree will be preserved (i.e. no impact) in accordance with the City’s Tree Protection Policy
  • 16 trees will be preserved with minor injury
  • Six (6) trees will be removed  as construction will severely impact the roots
  • One (1) tree came down during a wind/weather event and will be removed

Tree removals will begin Thursday August 23, weather permitting.

Soil Removal

The removal of the soil on top of the reservoir will soon begin Monday August 20, in order to expose the reservoir roof and begin work to repair and install the waterproofing membrane. The main impact as part of the work to remove soil will be an increase in truck traffic through Rosehill and Avoca Avenue.

  • Currently there is about 3 to 6 trucks per day that use the main access area near the Avoca Parks Yard (Avoca and Rosehill).
  • When soil removal begins, there will be 3 trucks per hour.

Portable washrooms will be installed in Little Park, west of the asphalt path (south of David A Balfour Park, near Summerhill Avenue) this week. One will be an accessible washroom.

The City is also working with the Contractor to review any options in the construction schedule to open up access to the park ahead of construction completion now that the temporary pathway at Avoca Avenue is closed. The City will share an update with the Community later this fall.

We appreciate your understanding and patience during this time as we work to upgrade this reservoir and ensure the delivery of safe drinking water to residents and businesses. We know this project has been a challenge and we are committed to working with community representatives and the Councillors’ offices to address issues that arise.

Apologies for not providing an update since late June. Staff have been reviewing concerns received from community members regarding the temporary (boardwalk) pathways both at the north-east corner of the park (Avoca Avenue) and at Little Park/south of Valve House.

Please read Construction Notice Update #1.

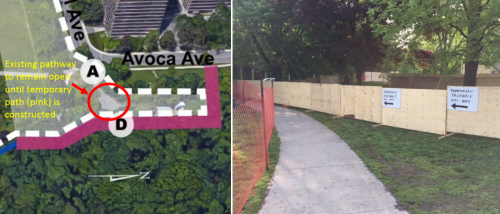

  • Access to the park via the north-east corner near Avoca Avenue will be closed due to safety concerns.
  • Signage will be developed and installed indicating detour route via Rosehill-Yonge-Summerhill. (The ravine network will remain open for those people who are accustomed to the local trails).

The washroom building will also be closed. Maintenance vehicles will not be able to access the washroom to perform the required maintenance. Portable washrooms will be located at the Summerhill entrance to the Park.

Ensuring the community’s safety around this active construction site is important and we thank you for understanding and ongoing patience.

The painting of the hoarding is almost complete and park lights on top of the reservoir and along the south and western side of the park will soon be removed.

Temporary Pathways

Temporary pathways have been put in place around the hoarding. The City is dedicated to keeping access to the remaining park space open during construction. A recent site visit was held with representatives from the community and local Councillors to discuss potential enhancements to increase visibility and mobility.

Unfortunately, the location of the reservoir is a constrained site and hoarding cannot be shifted any further to widen the temporary paths. With a focus on the temporary pathways at Little Park/Valve House and at the north-east corner near Avoca Parks Yard, the City will be taking further steps to:

  1. Install signage that clearly communicates the limited access, ask cyclists to dismount and dog walkers to have their dog remain on leash.
  2. Add large convex mirrors at the corners to help you see any movement/oncoming park users.
  3. Add lighting along the deck to illuminate the pathway only and in keeping with the Crime Prevention Through Environmental Design (CPTED) guidelines.

In addition to these activities, City staff are reviewing opportunities to install transparent material on hoarding panels located around the temporary paths and a bump-out space to pass/rest. A future update will provide more details.

An additional temporary pathway and stairway will be added for park users to have easier access to the Washroom and Rosehill Garden.

Rehabilitation Activities

Work has already begun to remove the reflecting pools. The stone wall along the cascade/fountain at Rosehill Avenue will also be removed.  You may also have noticed that the water molecule feature has now been removed. It will be preserved, as it is a heritage feature and incorporated into the new design.

Contractors have been reminded to start after 7 a.m. in keeping with the Noise By-law.

  • The hoarding and Tree Protection Zones are almost completely installed for phase 1 work.
  • Installation of temporary walkway at Avoca Avenue, around the Parks Yard, is underway.
  • Installation of temporary walkway from Little Park to the east side of the park is underway and expected to be completed by the end of next week.
  • The hoarding is being painted green.

Construction hoarding and Tree Protection Zones are almost completely installed.

Now that hoarding is almost installed, there is limited park space around the Garden. This is a gentle reminder to please be courteous to all park users and also to keep all dogs on leash.

Pathway

At the north-east part of the construction site at Rosehill and Avoca, the existing pathway (red circle on map) will remain open until the temporary pathway is constructed (pink line on map). Signage on the hoarding indicates the path is still open (photo). If there is any construction equipment movement in this area, a construction crew member will be nearby to ensure people can safely cross this part of the site.

The photo on the left shows an interim pathway through the construction site near the main access point at Avoca and Rosehill where crews provided a path for residents to cross. The photo on the right shows the hoarding and fencing in place while the temporary pathway is being constructed.
Avoca and Rosehill path and hoarding

Temporary Garbage Bins

Temporary garbage bins have been installed by the contractor at the Garden and Washroom. Solid Waste bins have been installed at the end of Jackes Avenue. The temporary bins will be in replaced Solid Waste bins.

Picture of the temporary garbage bins that are small round bins with lids
Temporary garbage bins

Tree Cutting

Tree cutting started May 23 for trees that are located on top of the reservoir and on the slopes. The removal of these trees are required to accommodate the installation of the reservoir’s waterproofing membrane.

Garbage Bins

The project team has received concerns about the garbage bins in and around the park. Many of the bins were removed before they were relocated to another spot outside of the construction hoarding.

The project manager has spoken with our colleagues in Solid Waste and they will be installing garbage and recycling bins next week at the following locations:

  • At the Rosehill Garden
  • At the end of Jackes
  • An additional set in Little Park
  • On Avoca Ave near the Parks Yard
  • At the washroom

Please note – No garbage bins will be located in the playground area since the perimeter path is not accessible for the Solid Waste collections vehicles. The garbage bin on Rosehill at the north-west corner of the Park will also not be replaced due to insufficient space provided with the temporary sidewalk.

We will also be scheduling a litter pick up of garbage left around the park. With the unfortunate timing of this issue, no clean-up crews can be scheduled for this work over the upcoming long weekend. We will provide you with the date once it has been scheduled.

Temporary Pathways

  1. Ramp to the Garden — The contractor will be installing a temporary ramp from the Valve House to the Rosehill Garden, since part of the existing path will be inside the hoarding. This ramp will run from the Valve House, next to the hoarding and tie into the existing path to the Garden. This ramp is being inserted into a packed construction schedule and the contractor is expecting the installation within the next four weeks.
  2. In addition the following temporary pathways will also be installed with the hoarding over the next 3-4 weeks:
    1. Temporary Pathway from Avoca Ave to the Perimeter path (around Avoca Parks Yard)
    2. Temporary Sidewalk (along the south side of Rosehill Ave, adjacent to the Park)

On Monday April 30, installation of hoarding and tree protection zones will begin and continue to take place for the next few weeks. The white-shaded area (not the dash lines) on the map show where hoarding will be installed on the west side of the park.

Rosehill Reservoir Phase 1 hoarding. This hoarding surrounds the west side of the park (which is closed) and leaves open the south-east side of the park
Rosehill Reservoir Phase 1 hoarding

Construction crews will be doing locates on site starting April 24 and April 25 including Little Park, inside site buildings and chambers. They may use spray paint, wooden stakes and small flags to mark buried service lines. This work will take place within the hours set by the noise by law (7 a.m. to 7 p.m.) and will take place prior to the installation of hoarding.

Rehabilitation work on the reservoir is scheduled to begin in April 2018 with the placement of hoarding (wooden fence) around the perimeter of the west side of the reservoir. This area of David Balfour park will be closed to public access until Phase 3 of the rehabilitation project. The east side of the reservoir will remain open to the public until Summer 2019.

A Public Drop-In Event took place on Monday, March 19 from 6 to 8 p.m. at Yorkminster Park Baptist Church (Heritage Room), 1585 Yonge Street.  Members of the public were invited to drop in during this time to learn about the rehabilitation of the reservoir, the details of the construction process and efforts to mitigate impacts. City of Toronto staff were present to answer any questions and receive feedback from the public. See the Public Consultation tab for additional information about this event.

Residents in neighbourhoods around the reservoir were sent a Construction Notice in the mail that explains the phases of construction. Properties that are within close proximity to the site will also receive a notice regarding pre-construction inspections.
